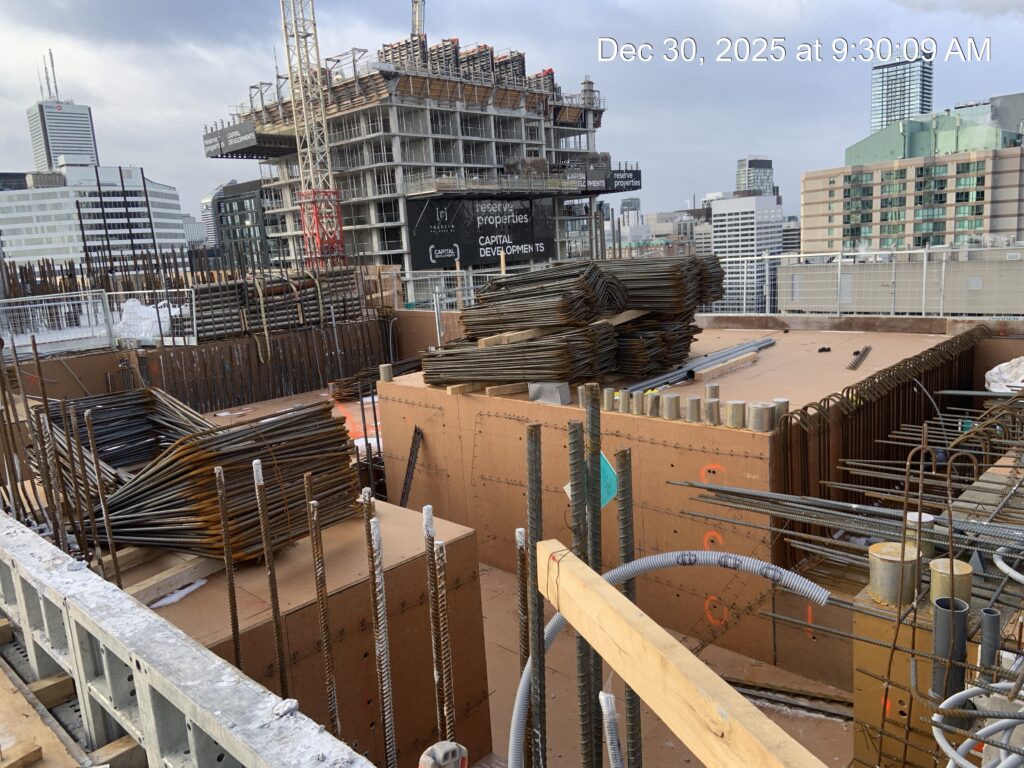

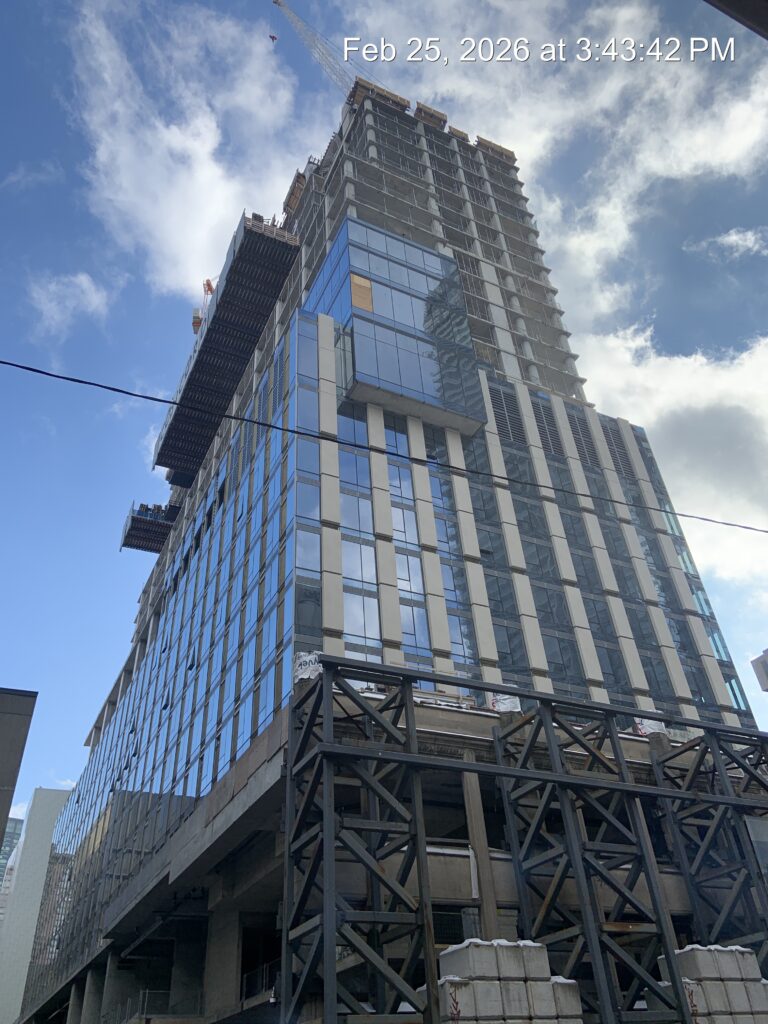

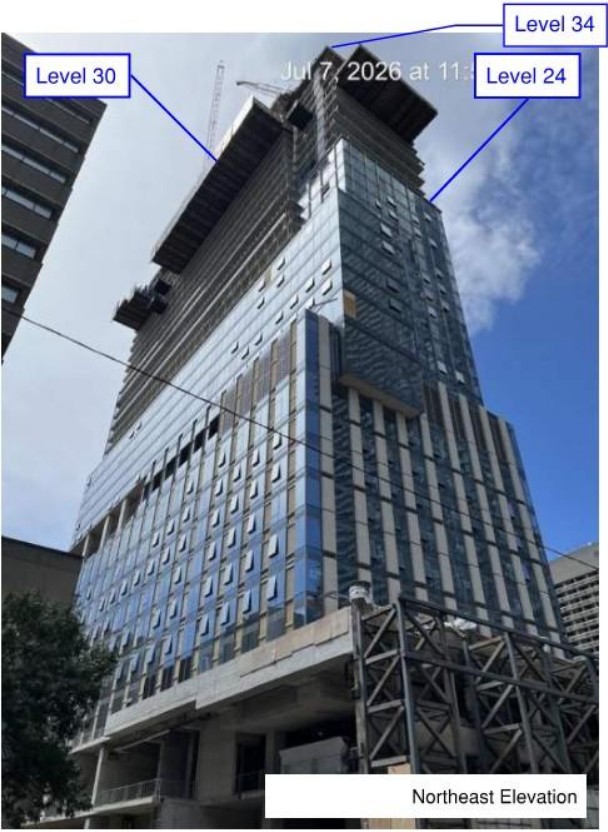

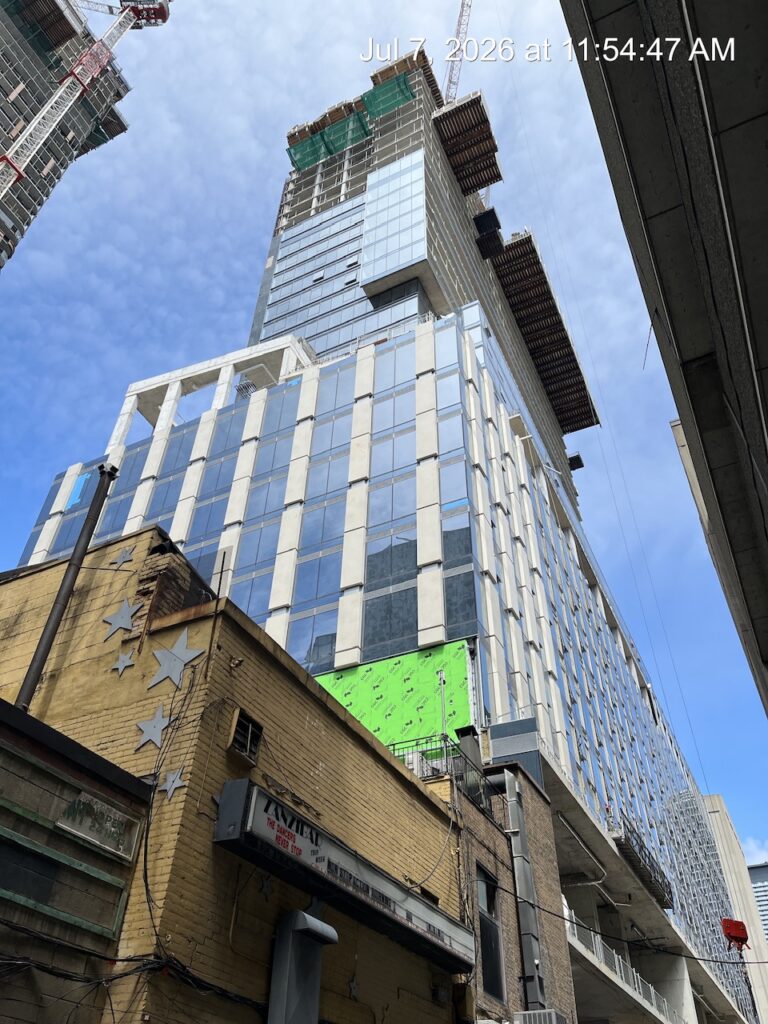

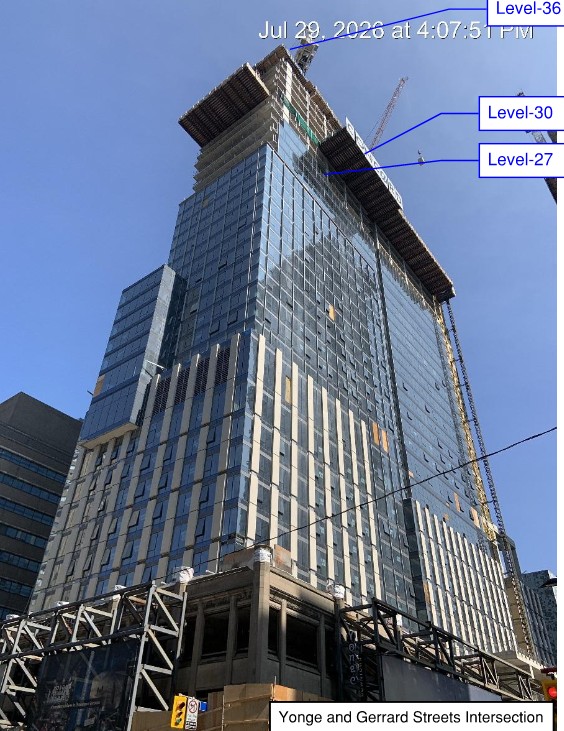

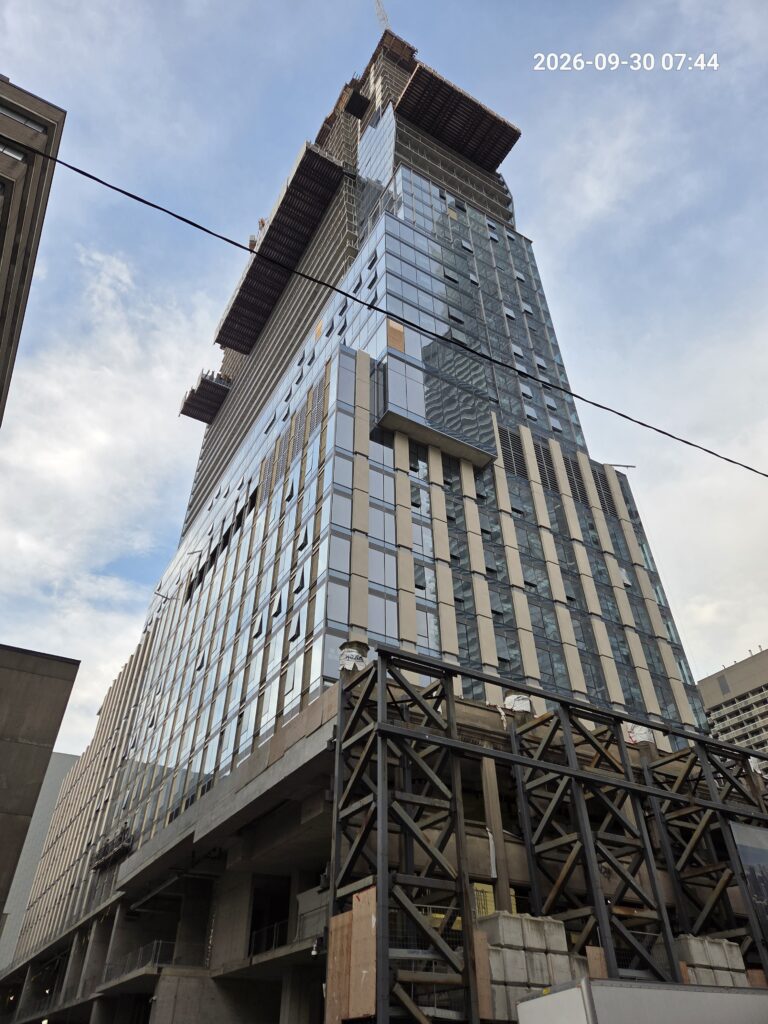

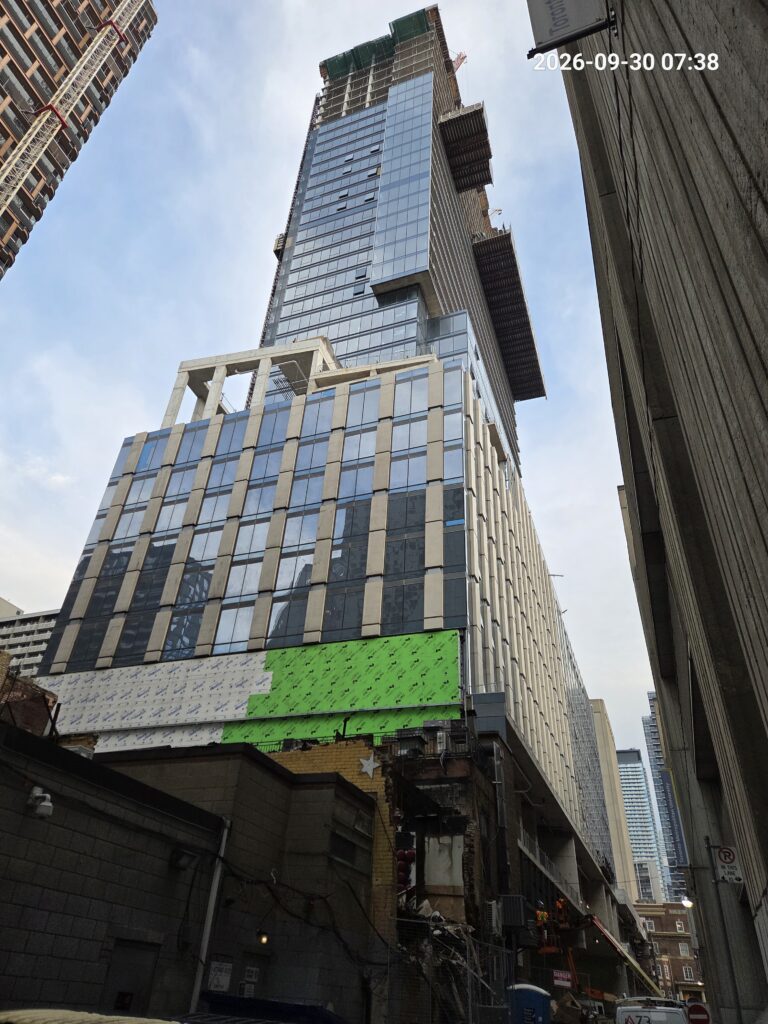

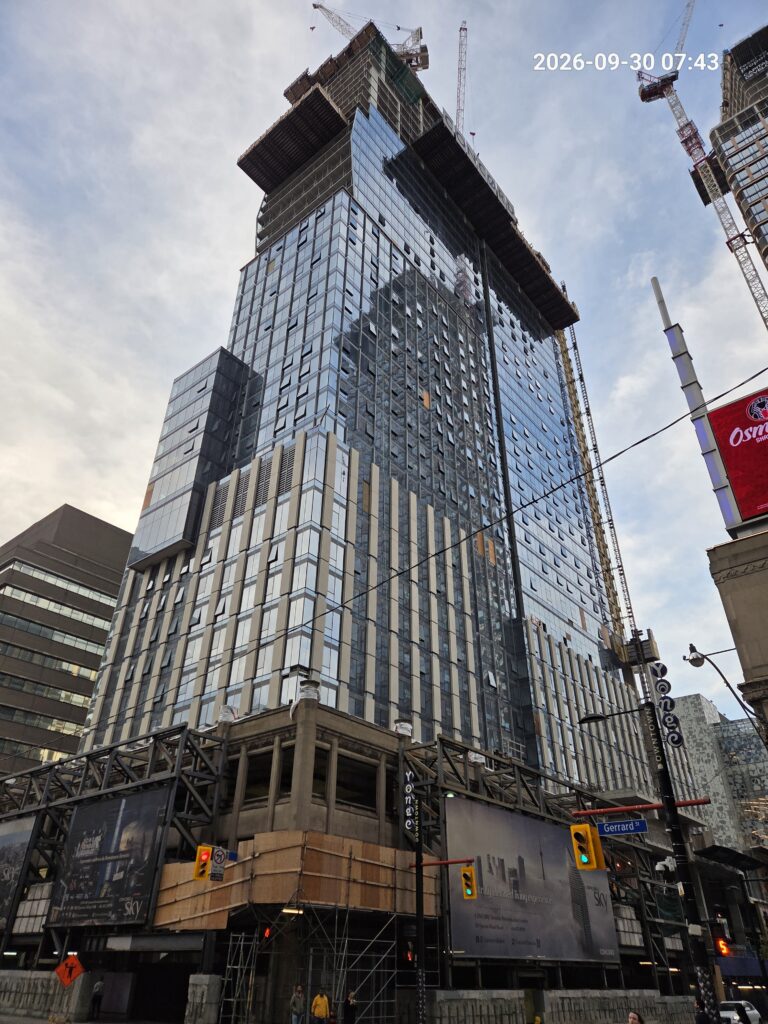

Concord SKY Project Construction Status December 2025

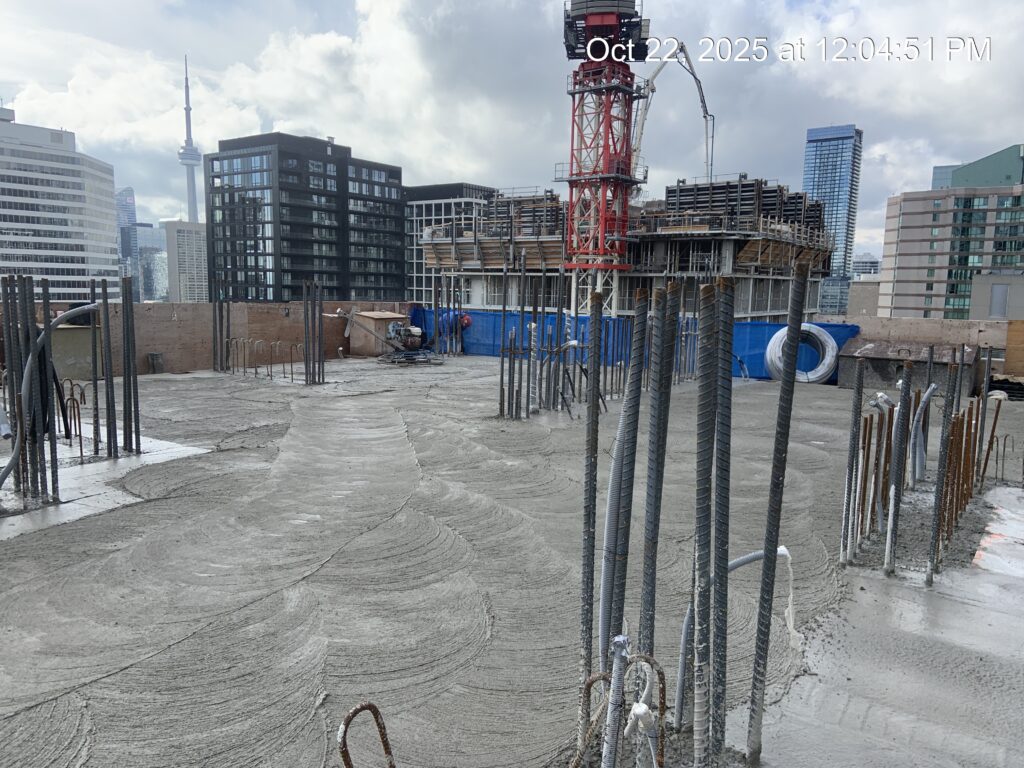

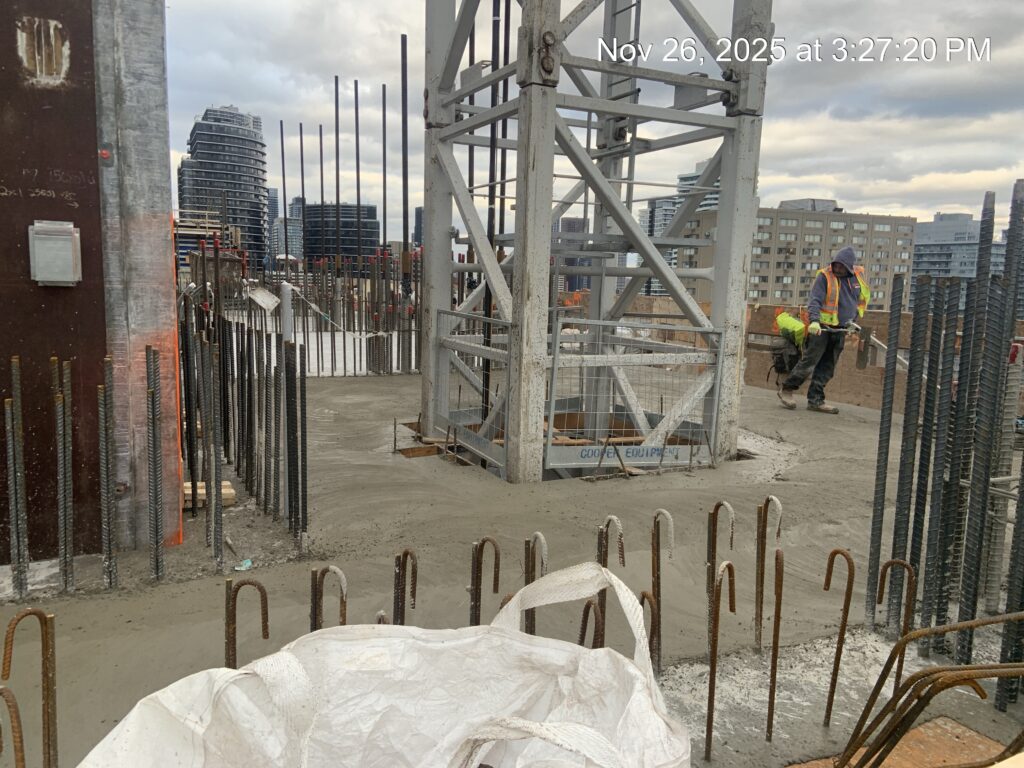

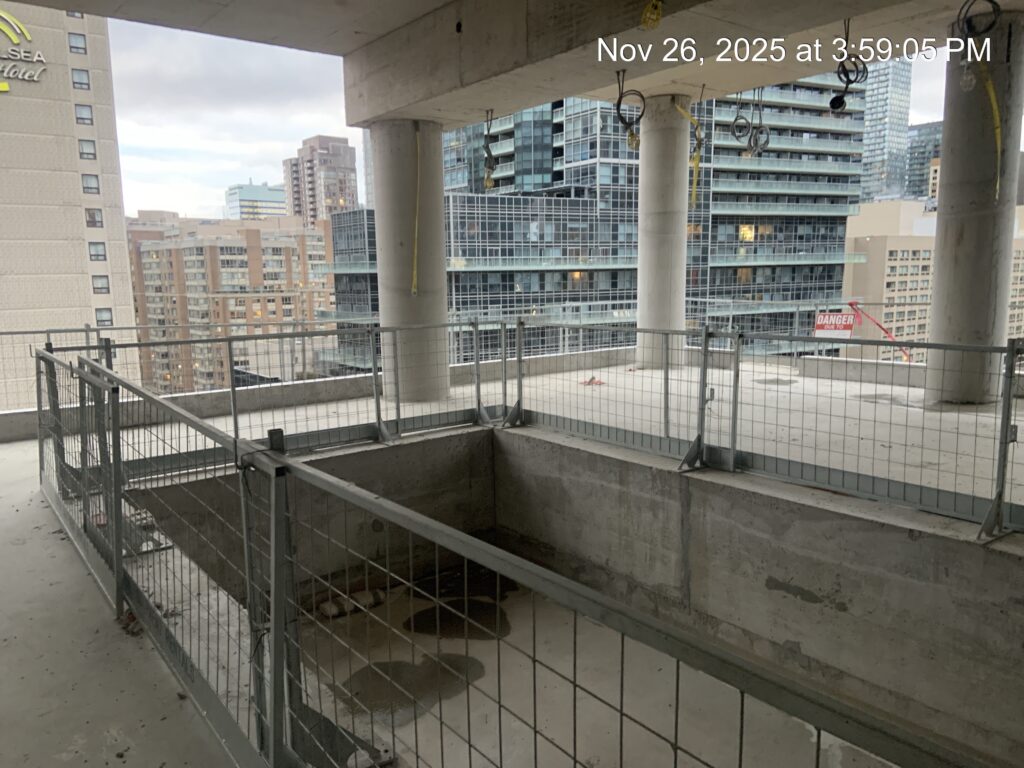

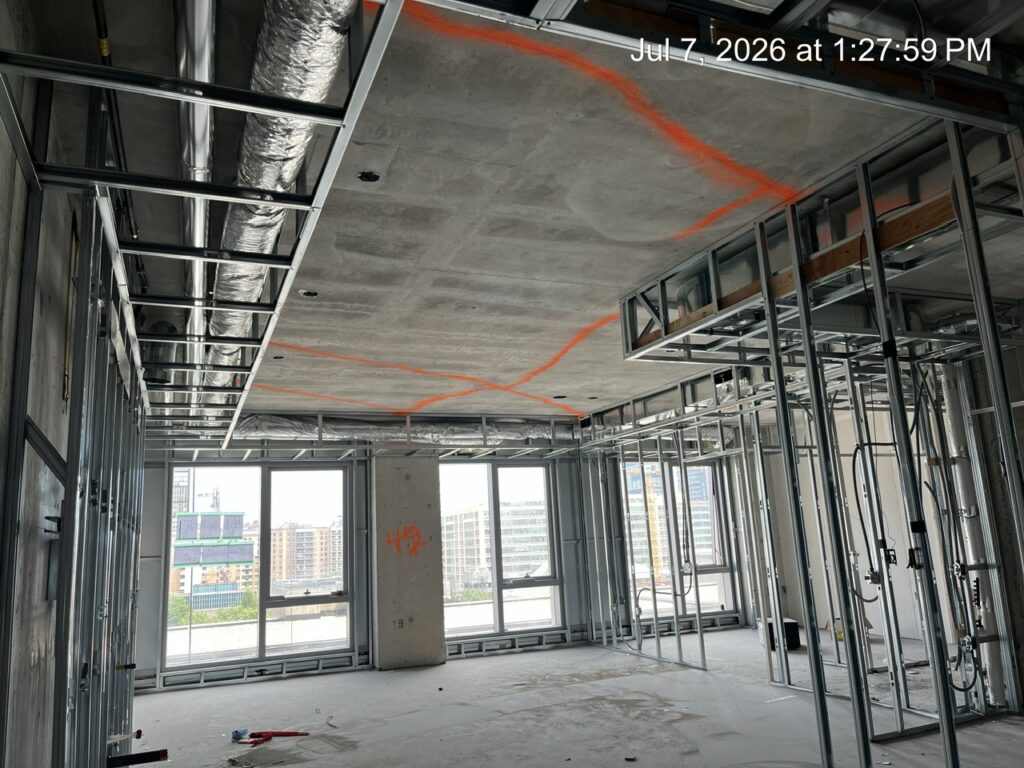

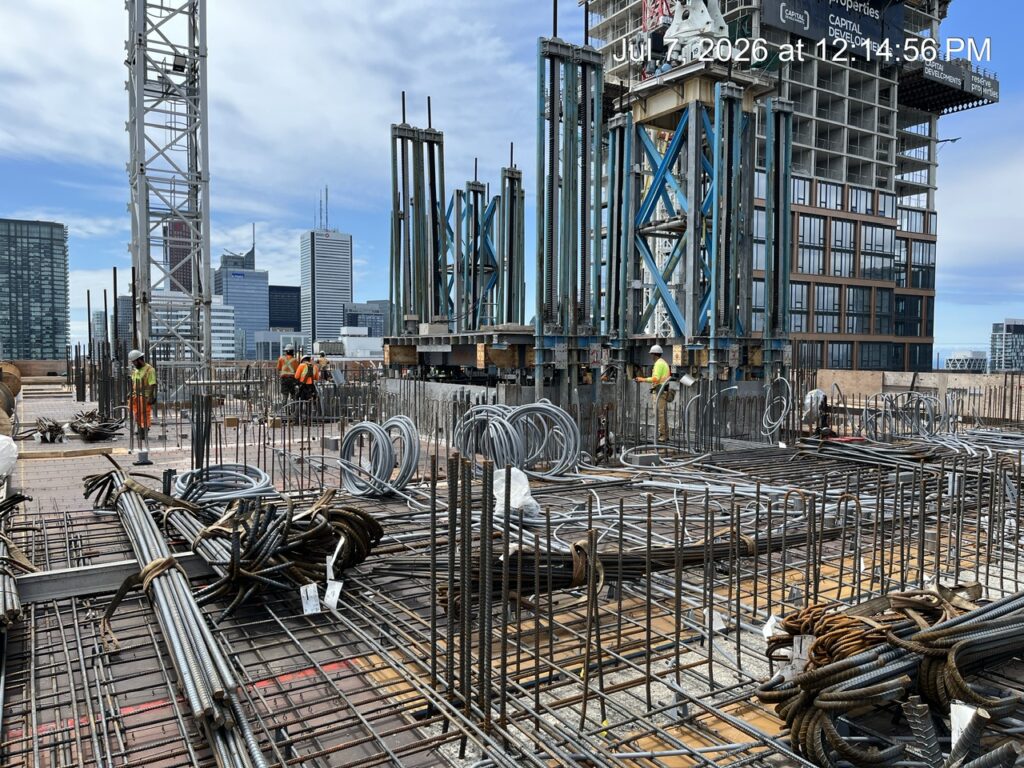

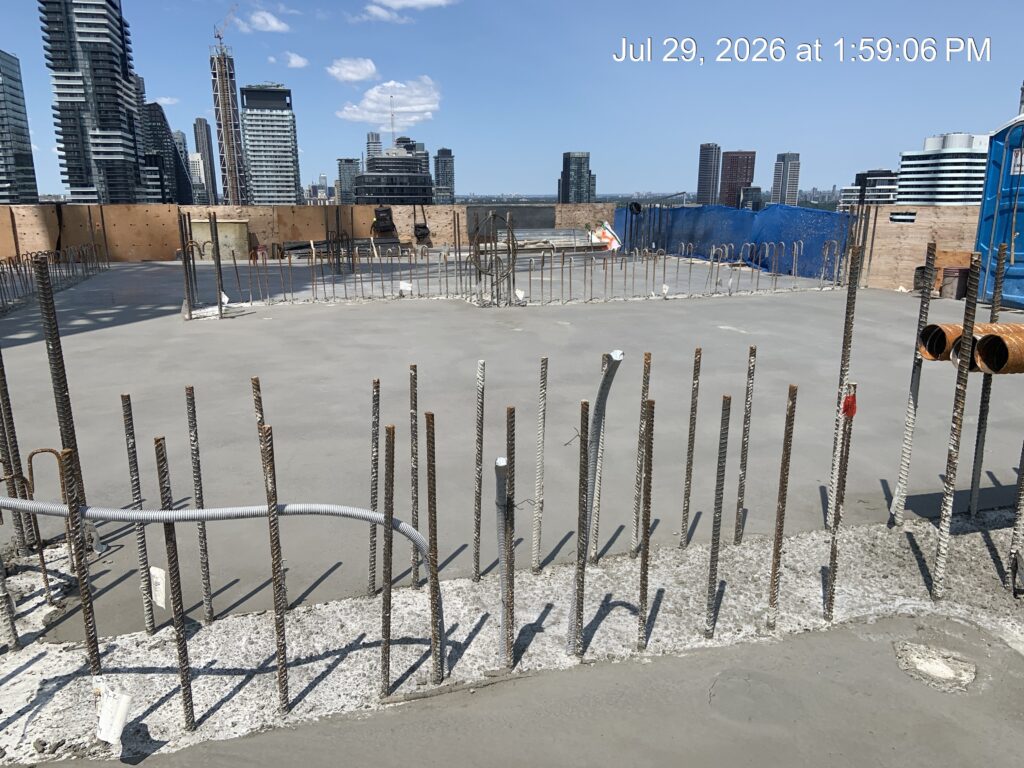

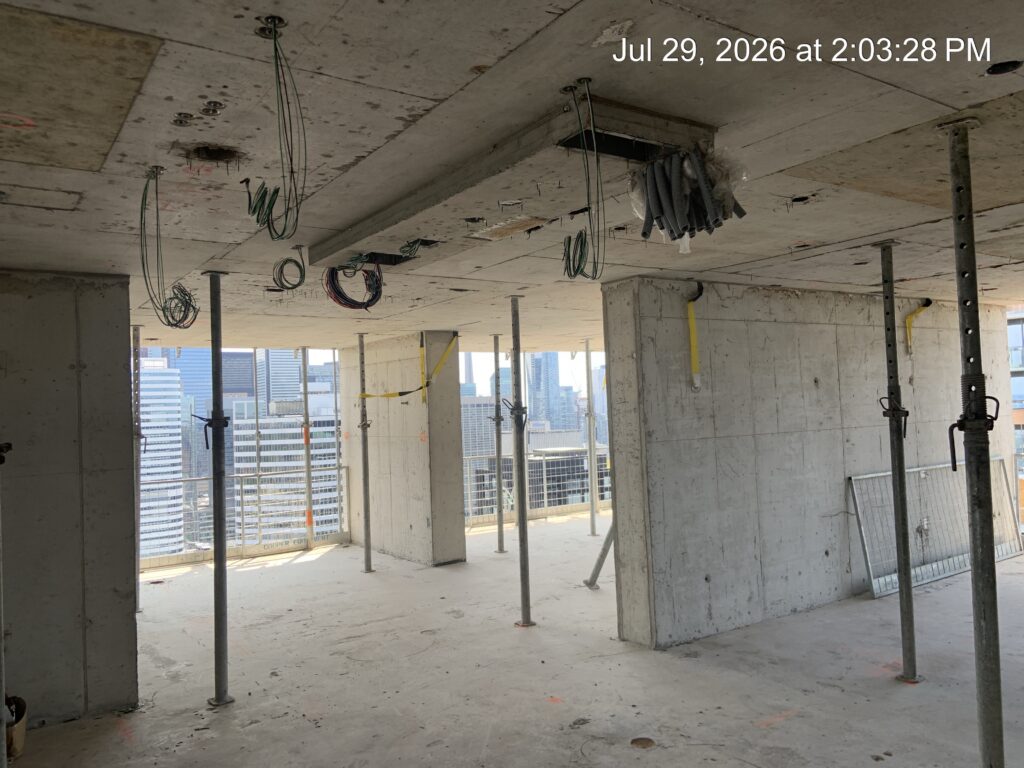

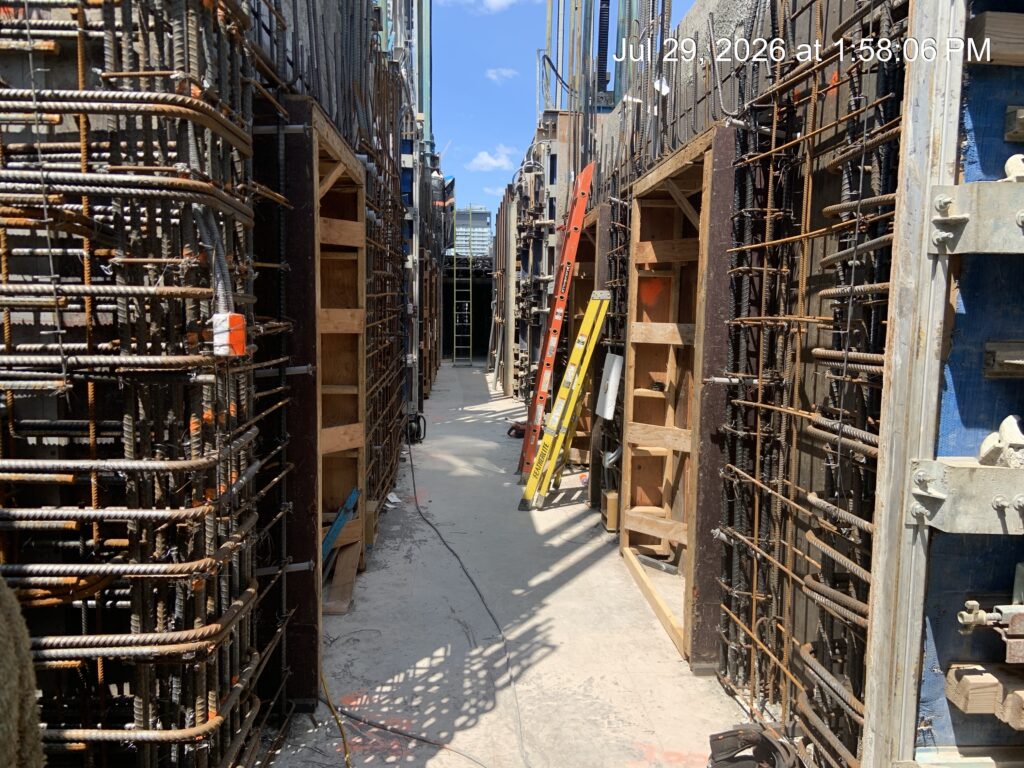

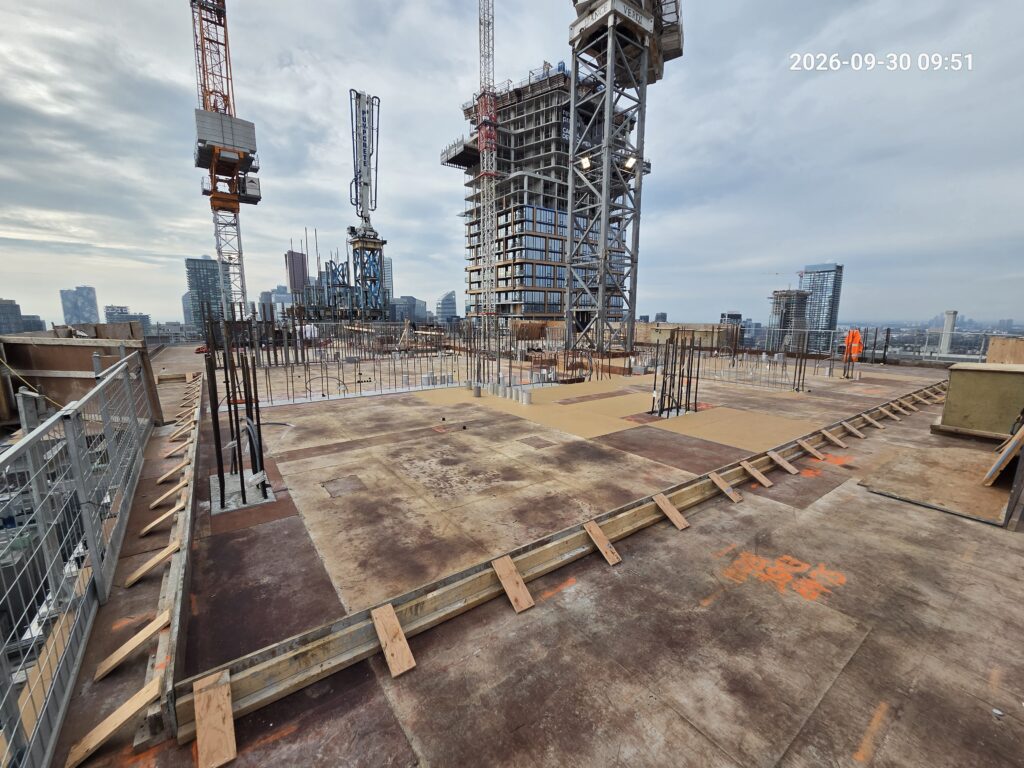

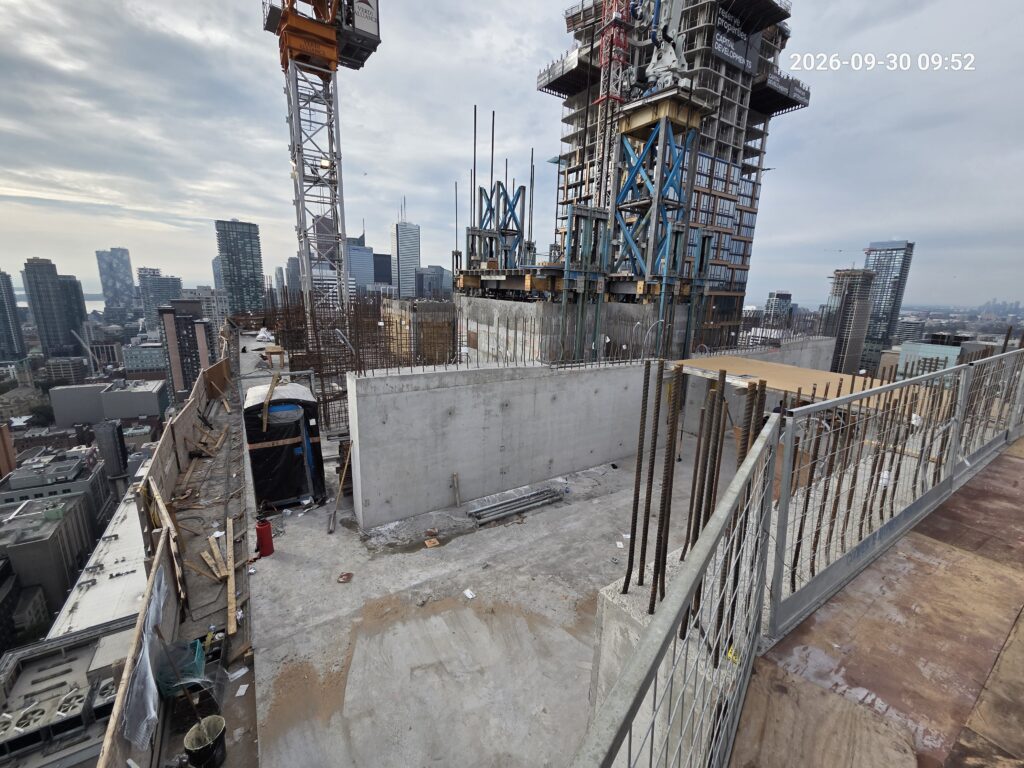

  • Concrete pouring at level 24 is ongoing.

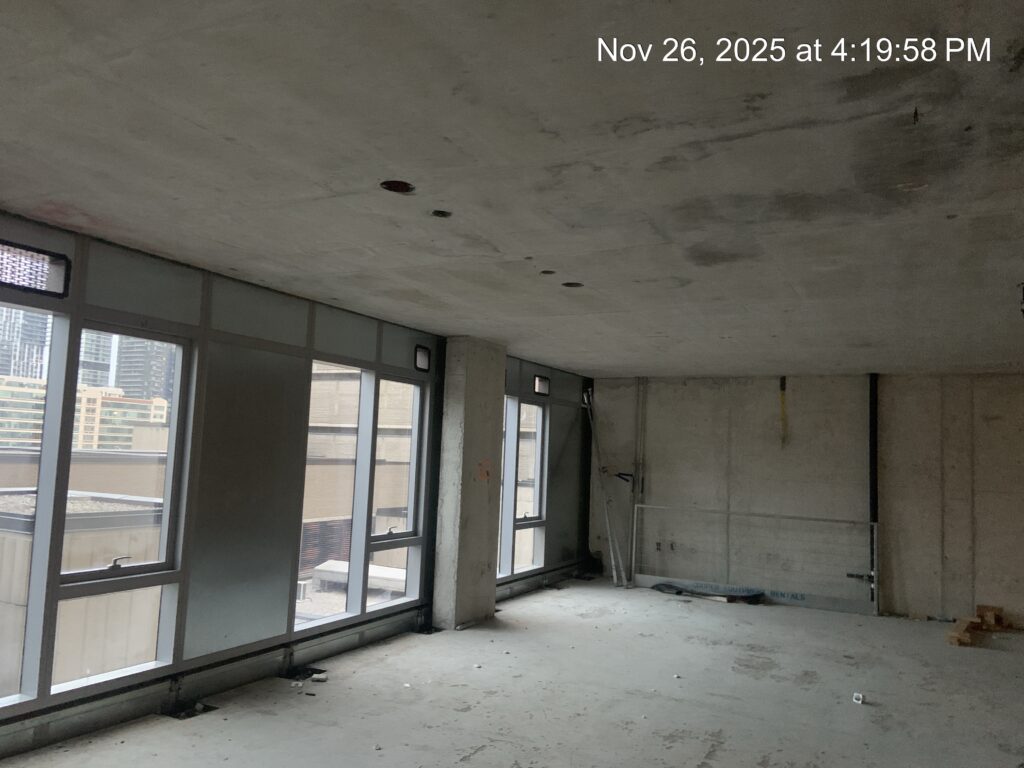

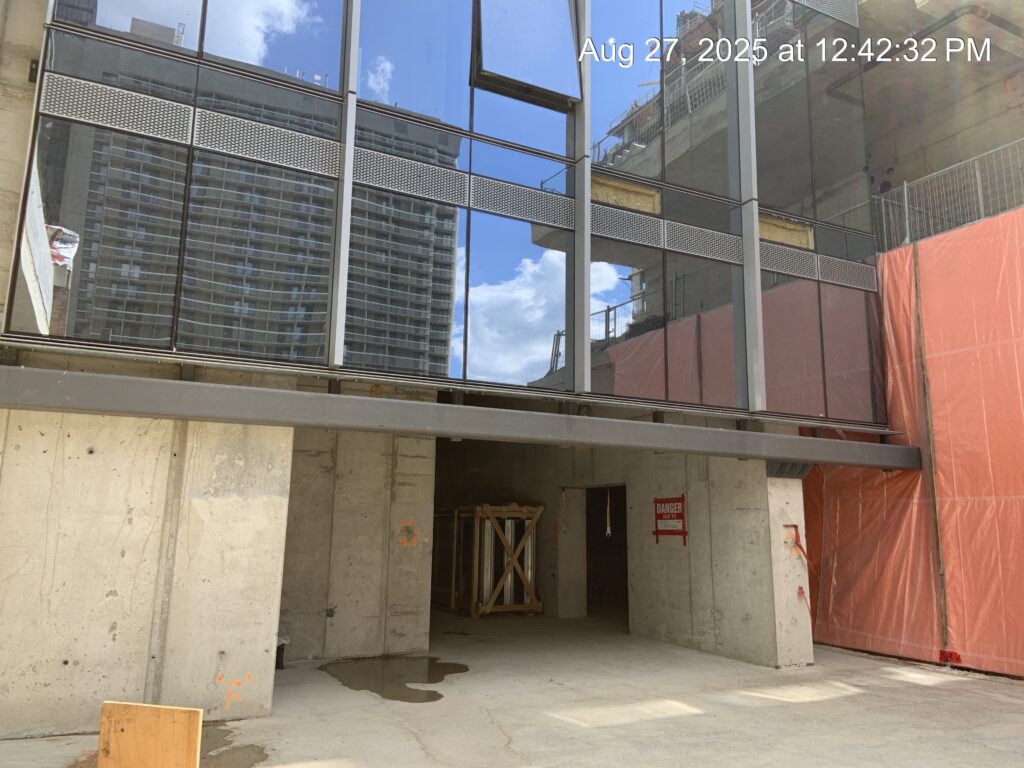

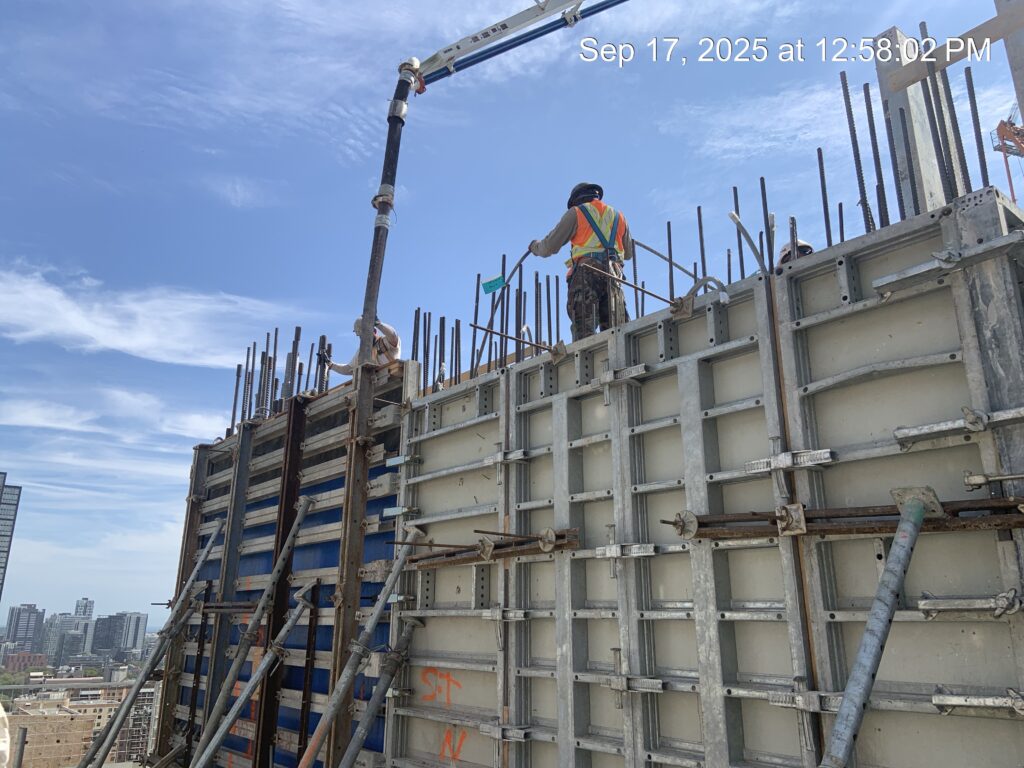

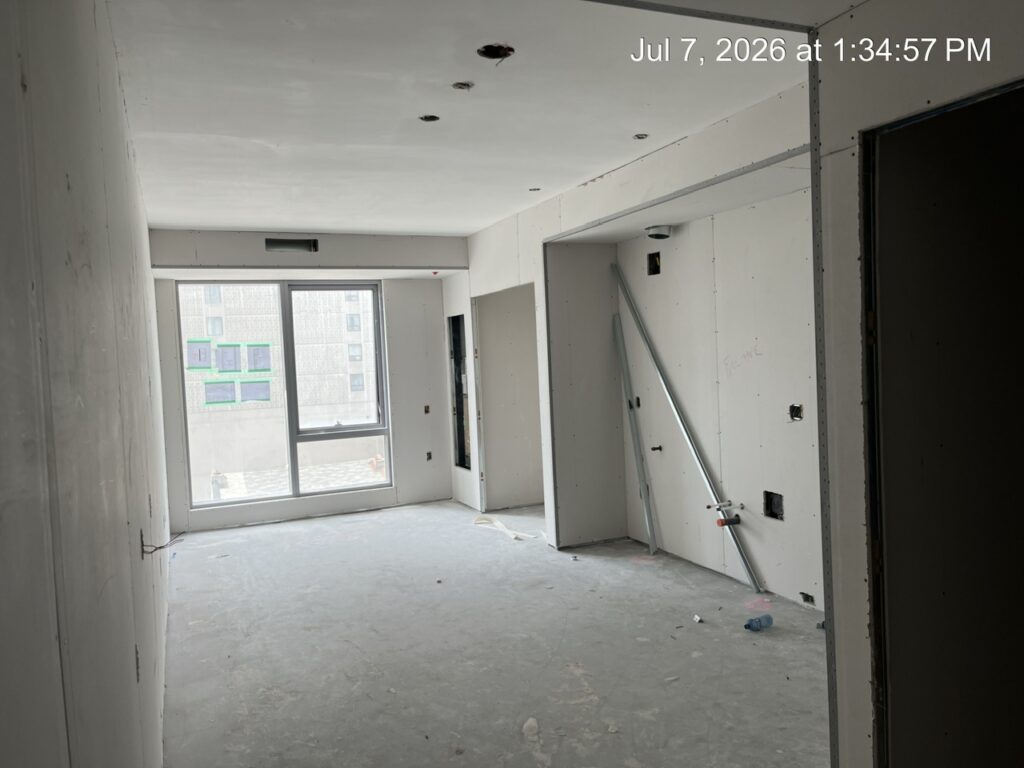

  • Curtain wall installation from level 4 up to at level 9 completed.

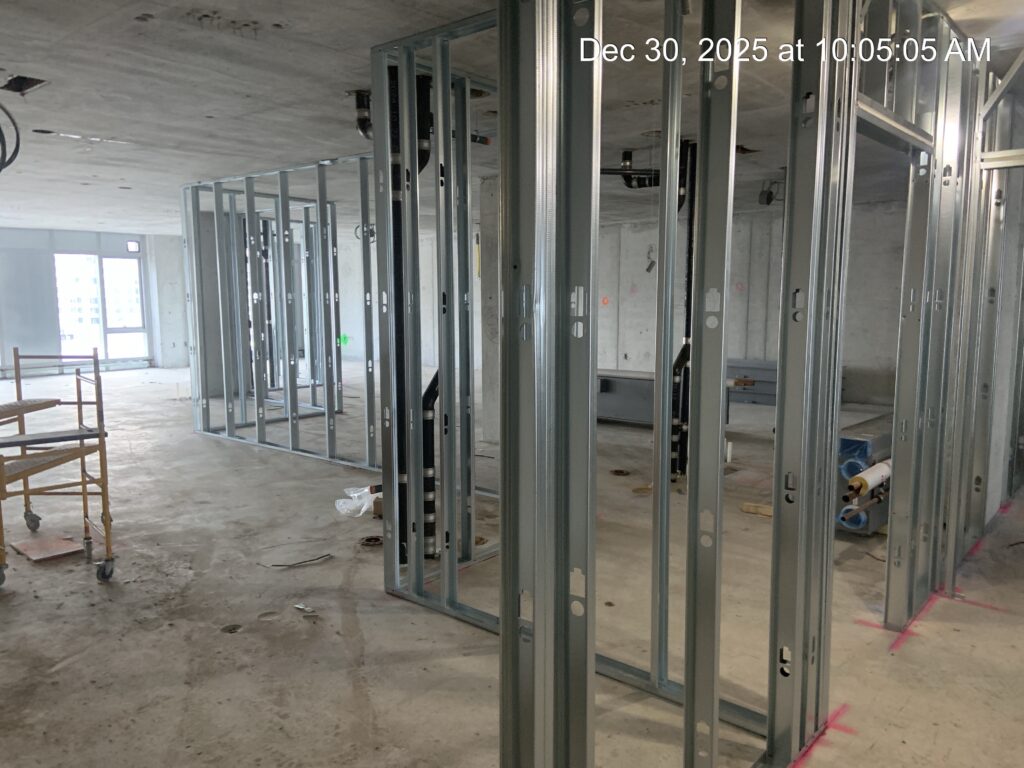

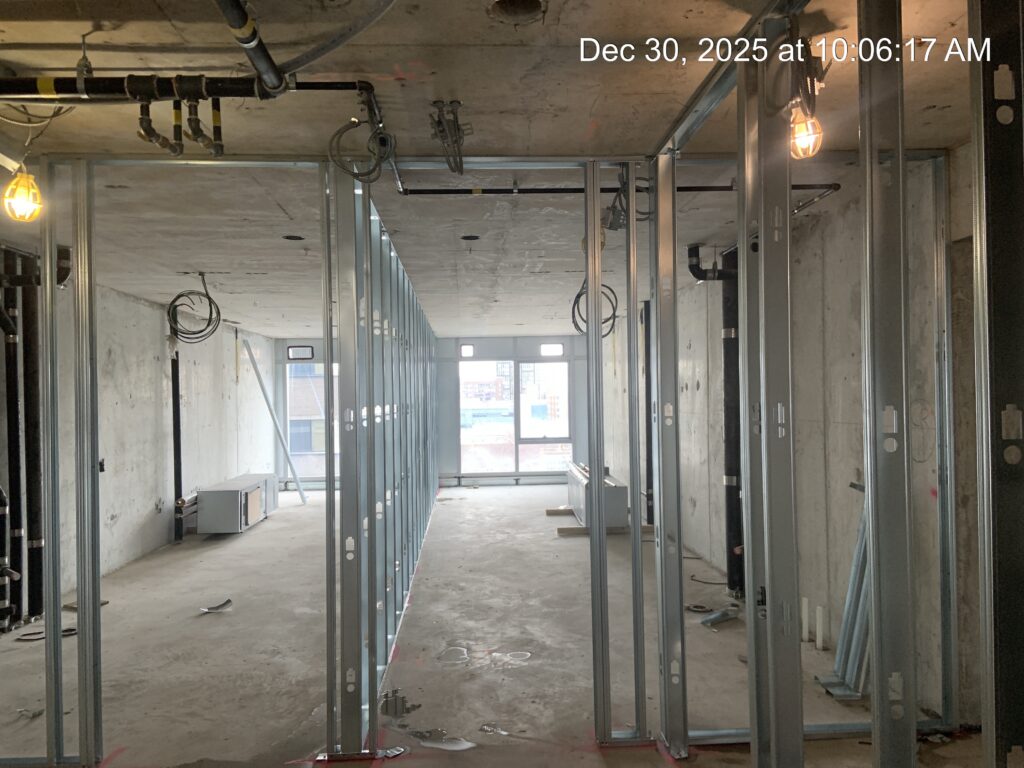

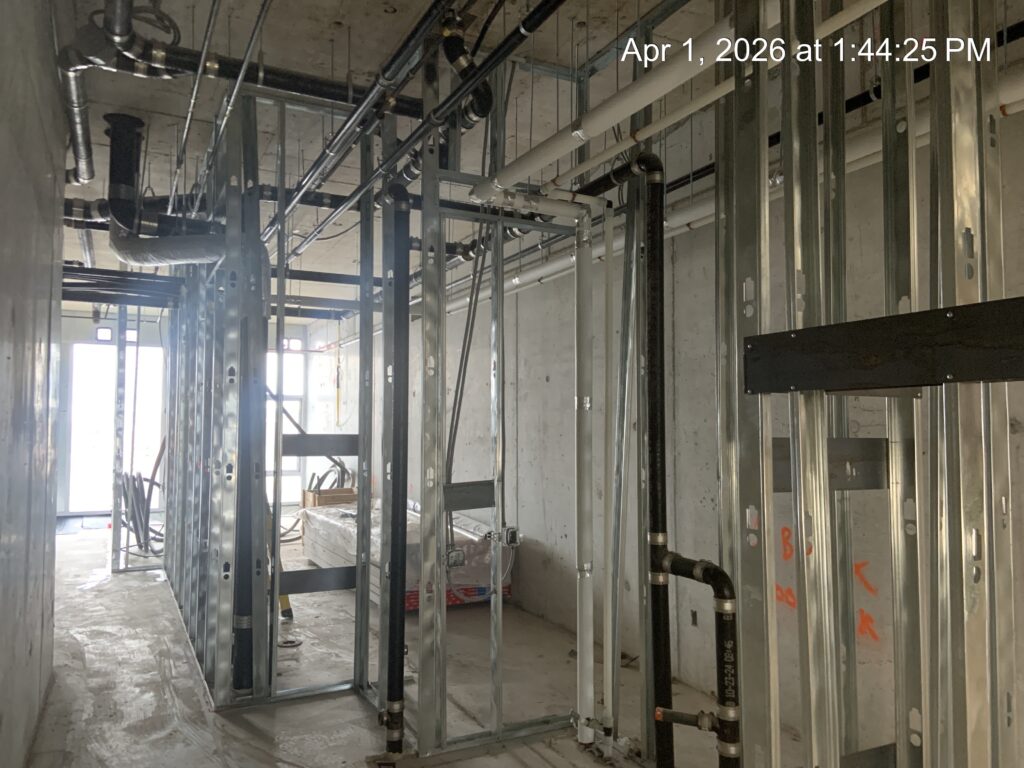

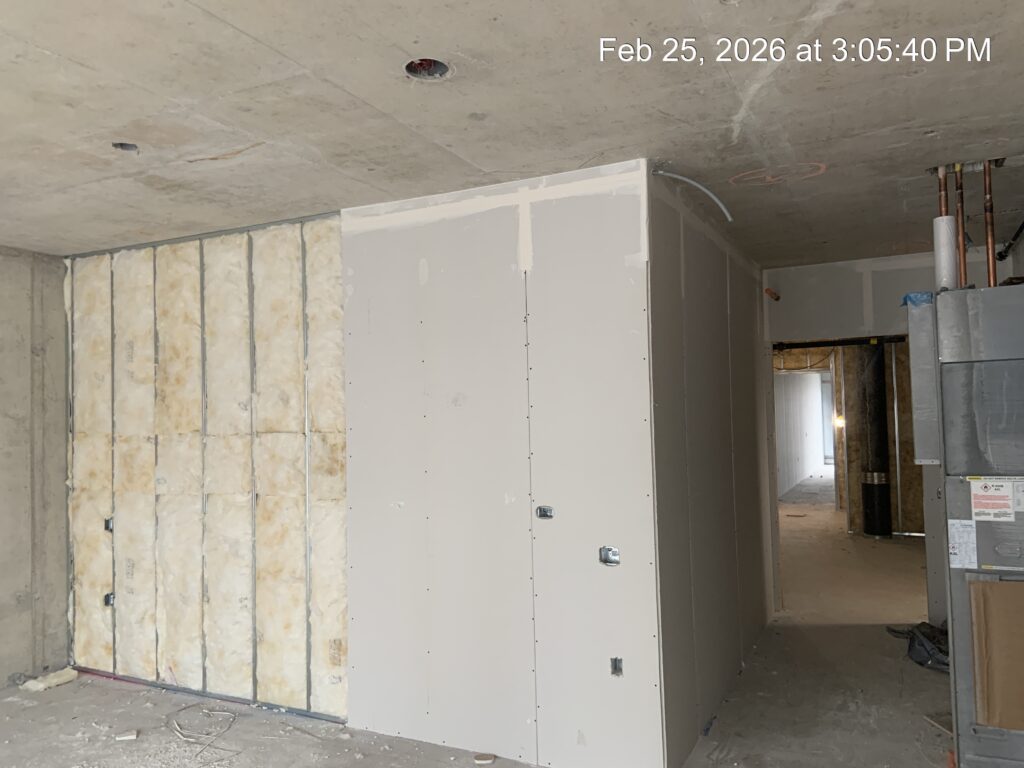

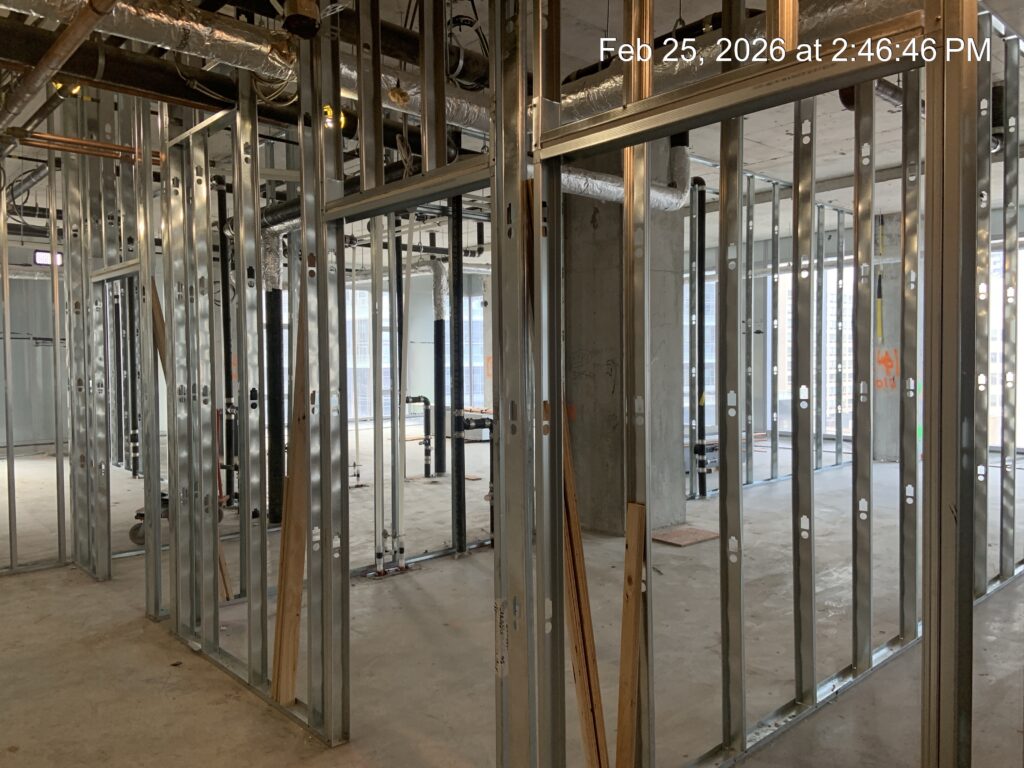

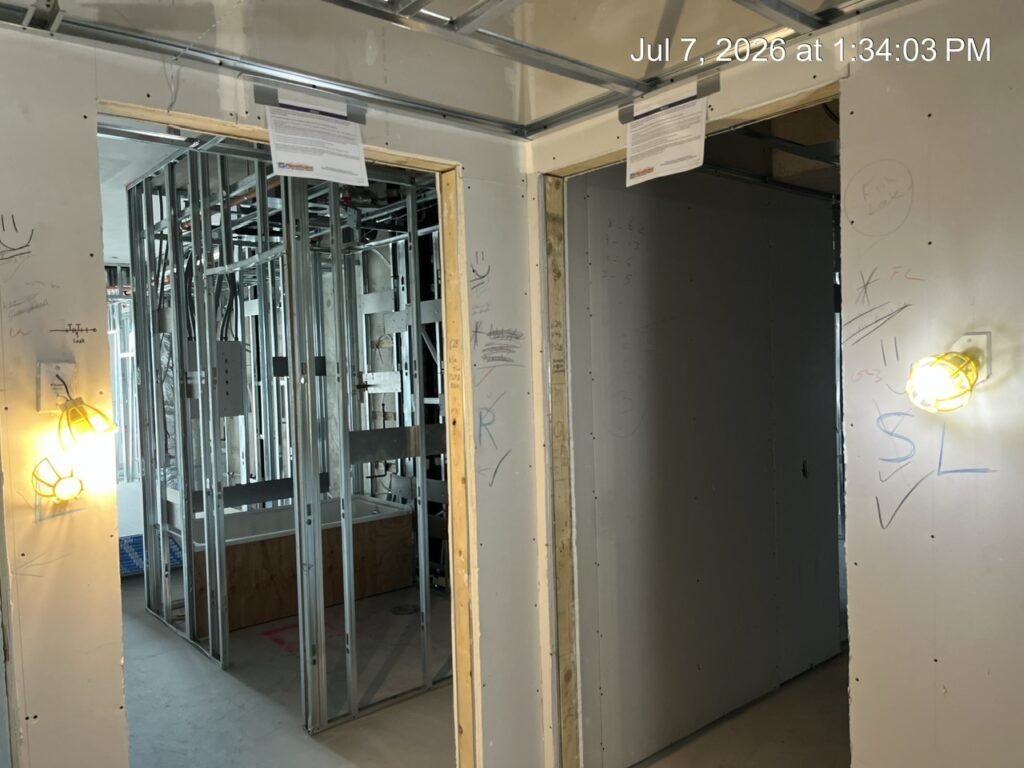

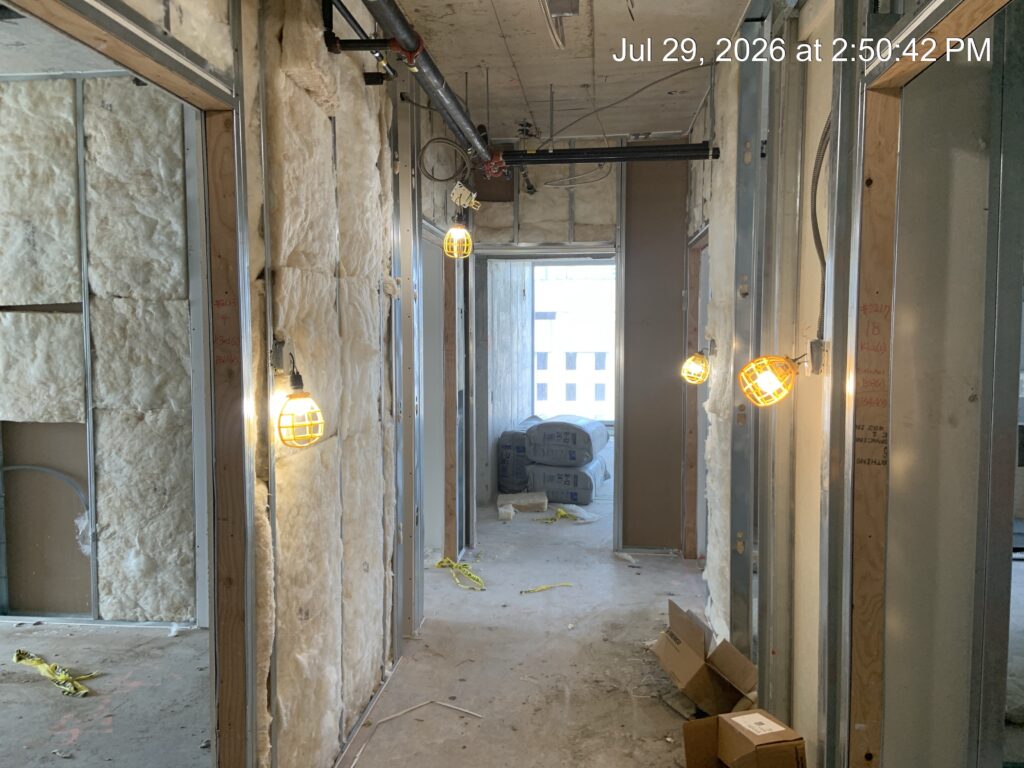

  • Corridor and demising wall framing are ongoing on level 4, 5, 6, and 7.
  • Porcelain cladding installation completed up to level 9 of the north elevation.

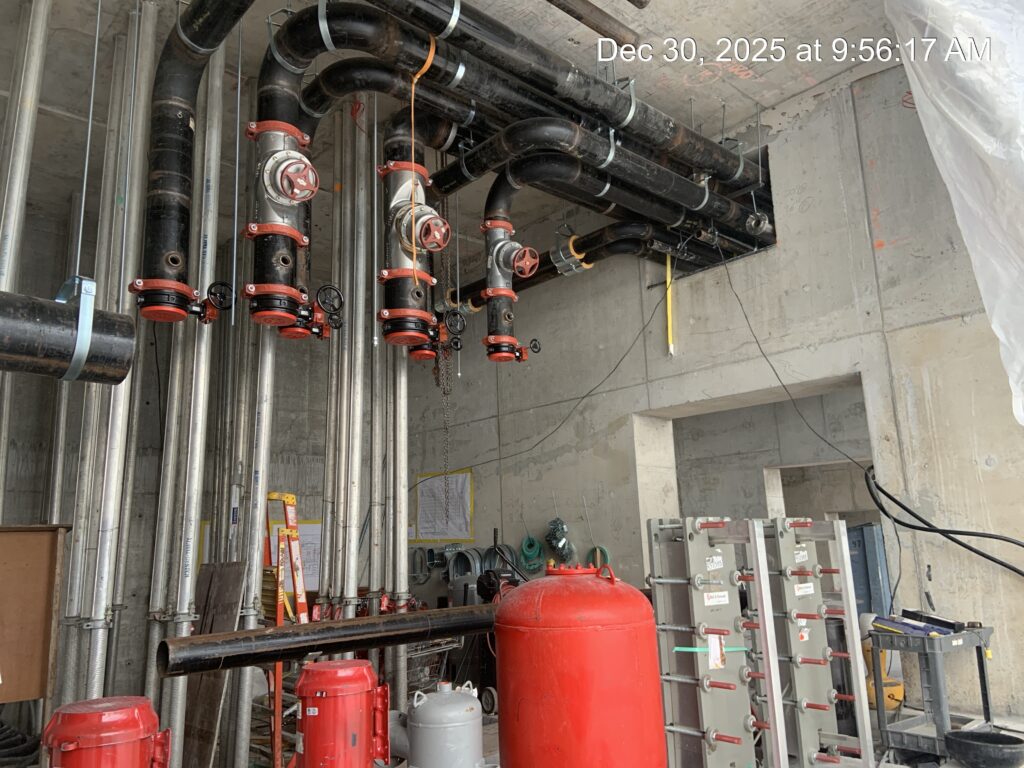

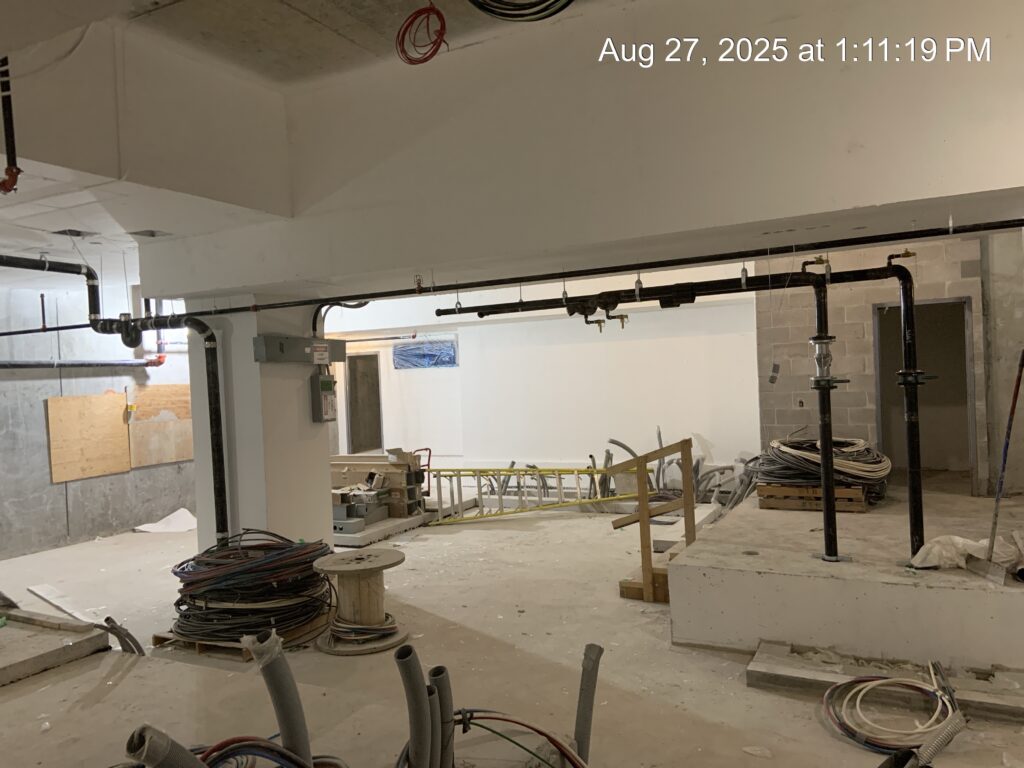

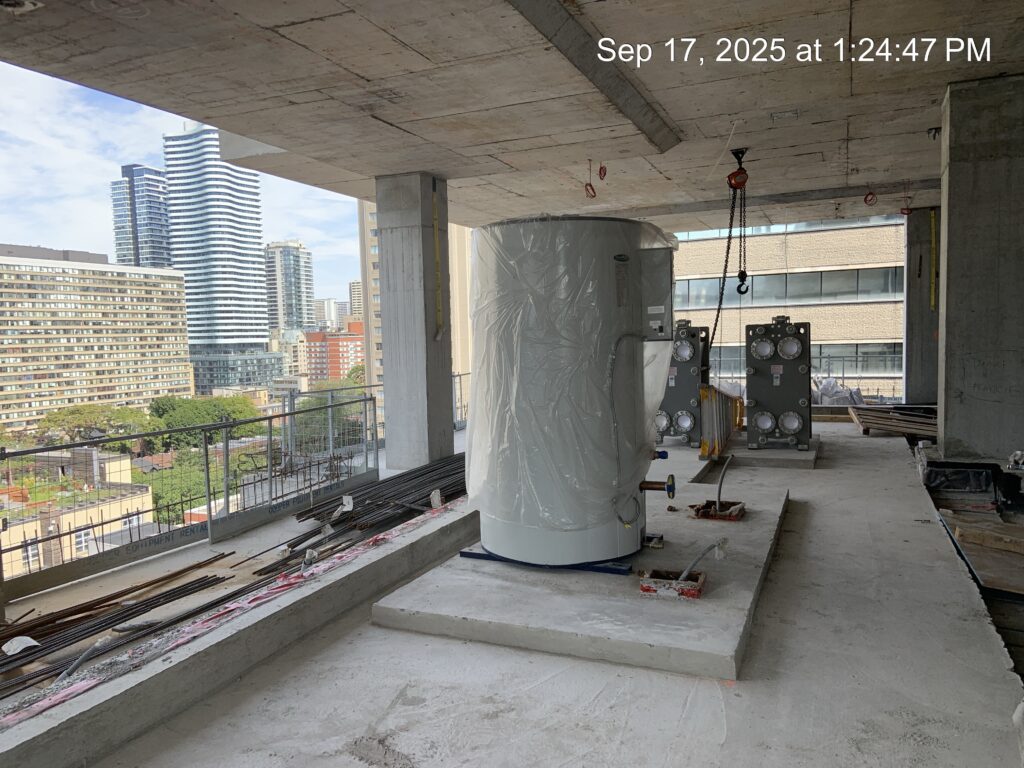

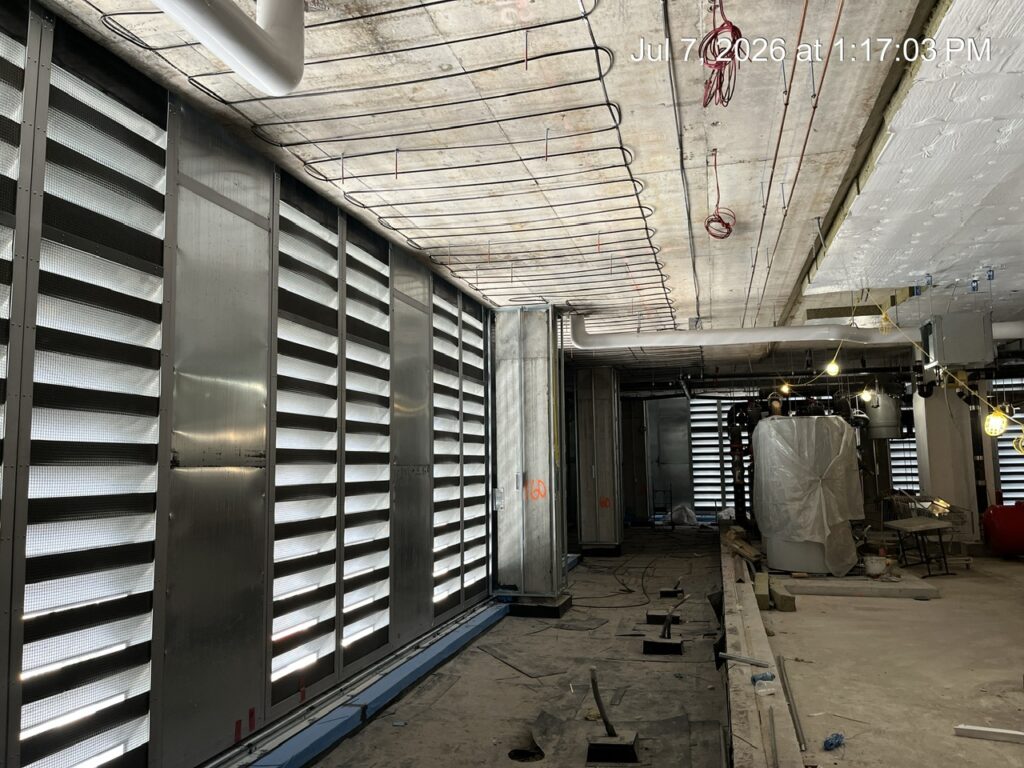

  • HVAC installation is ongoing from level 2 upwards.

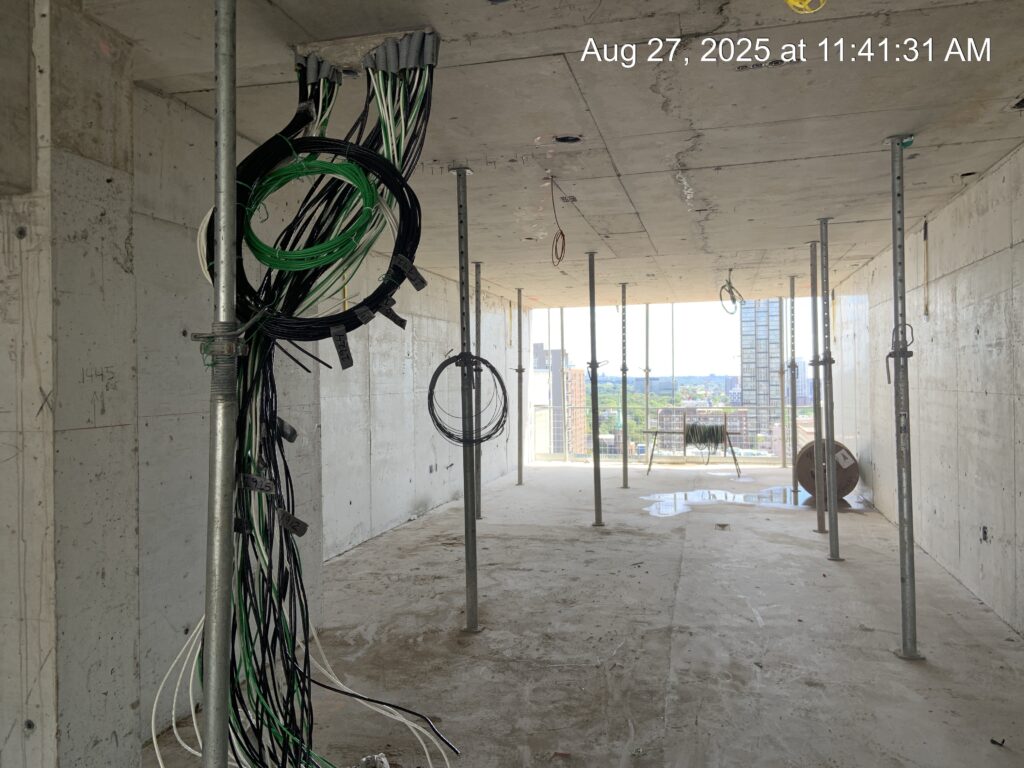

  • Electrical wire pulling in progress at level 22.
  • Permanent lights installation at stair A & B from ground floor up to level 9 is ongoing.

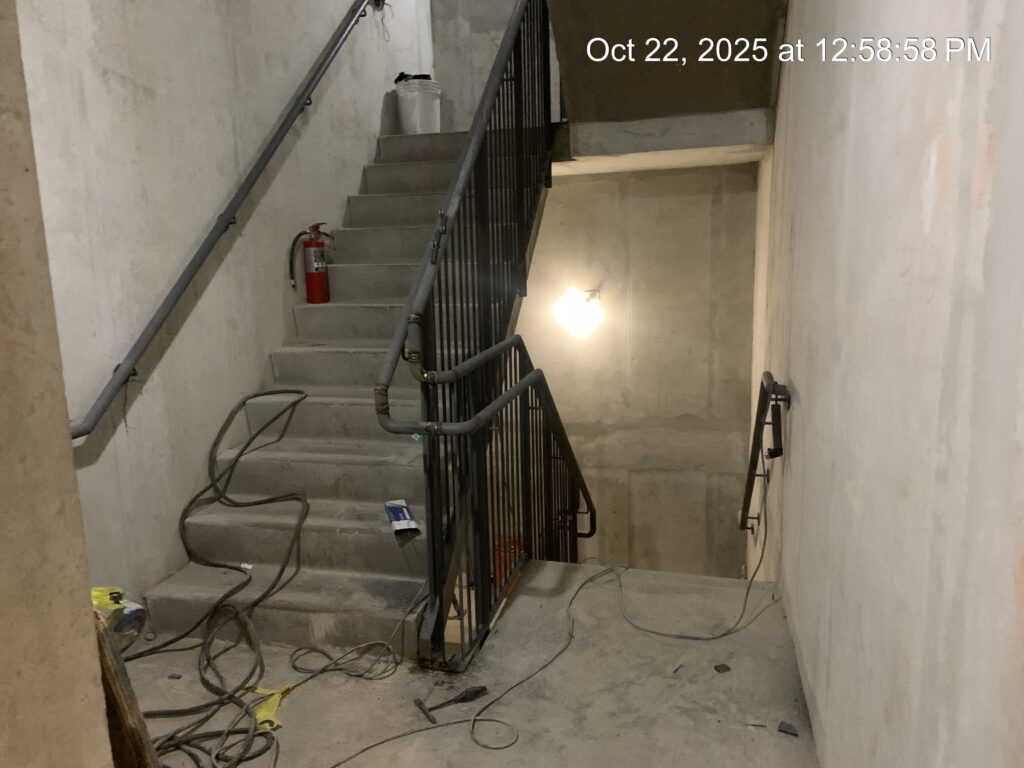

  • Stair railing installation up to level 20 is ongoing.

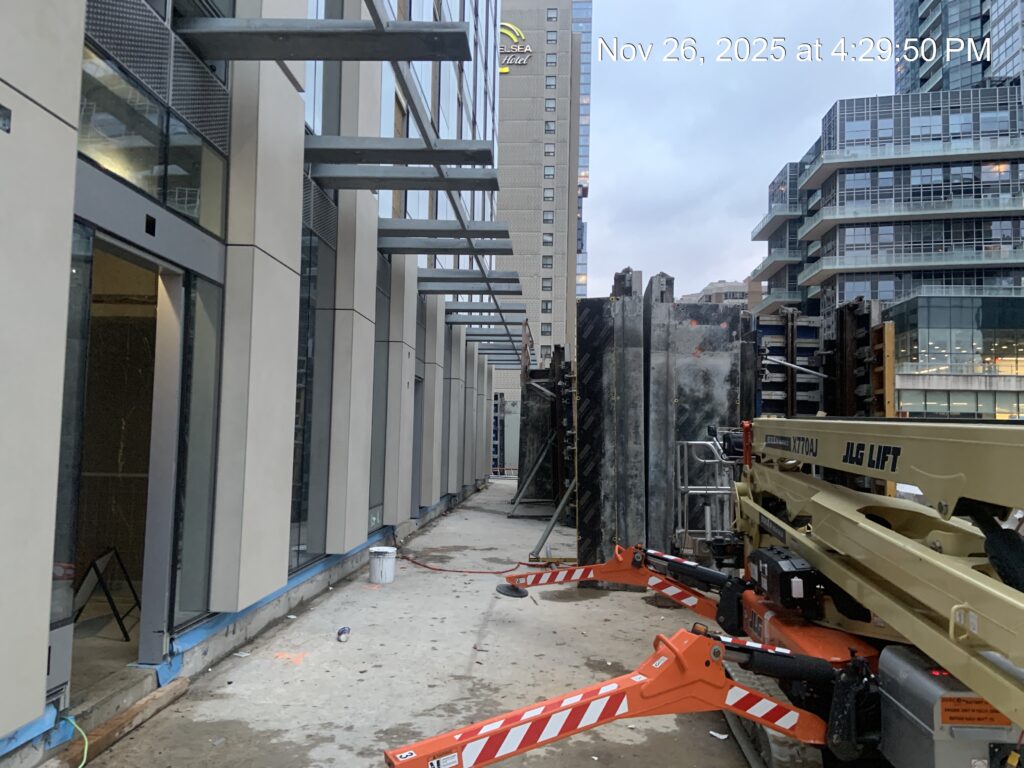

Concord SKY Project Construction Status-November 2025

  • Concrete pouring at Level 23 is completed
  • Decking work started at level 24
  • Vertical elements between Levels 23–24 is ongoing

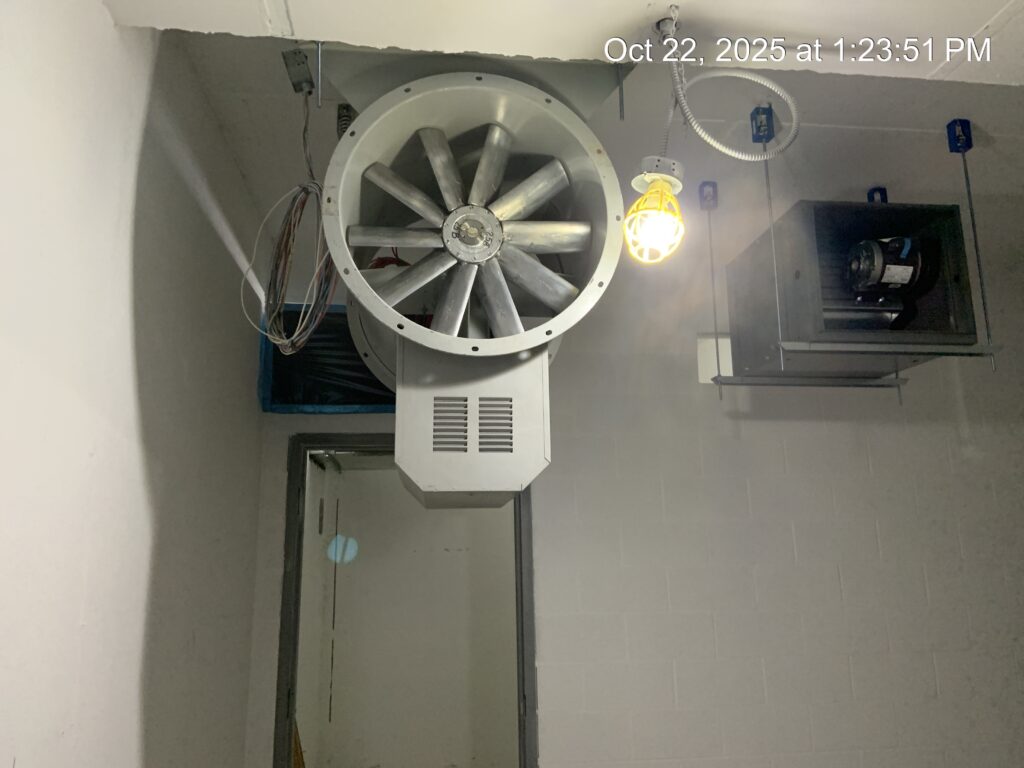

  • HVAC installation is ongoing from Level 2 upwards.
  • Electrical: wire pulling in progress at Level 20.
  • Curtain wall installation at Level 9 is ongoing and the south elevation from level 4 to 9.
  • Installation of the exterior porcelain panels at the north elevation started.
  • walls framing at level 4 started.

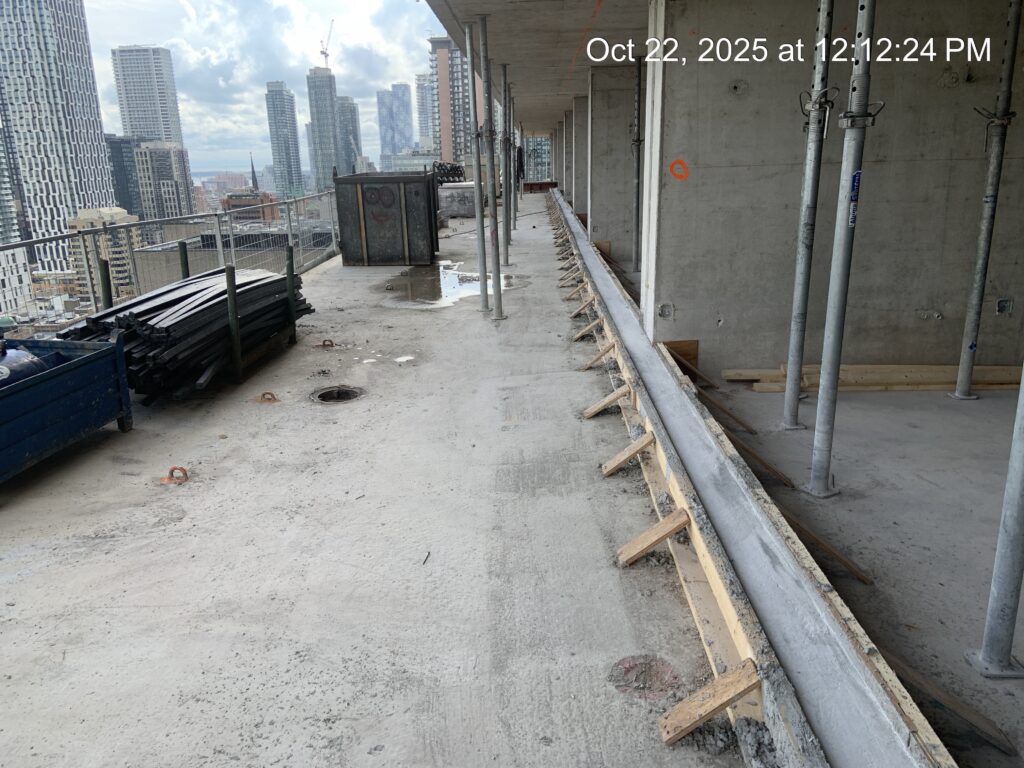

Concord SKY Project Construction Status-October 2025

Site Progress Summary

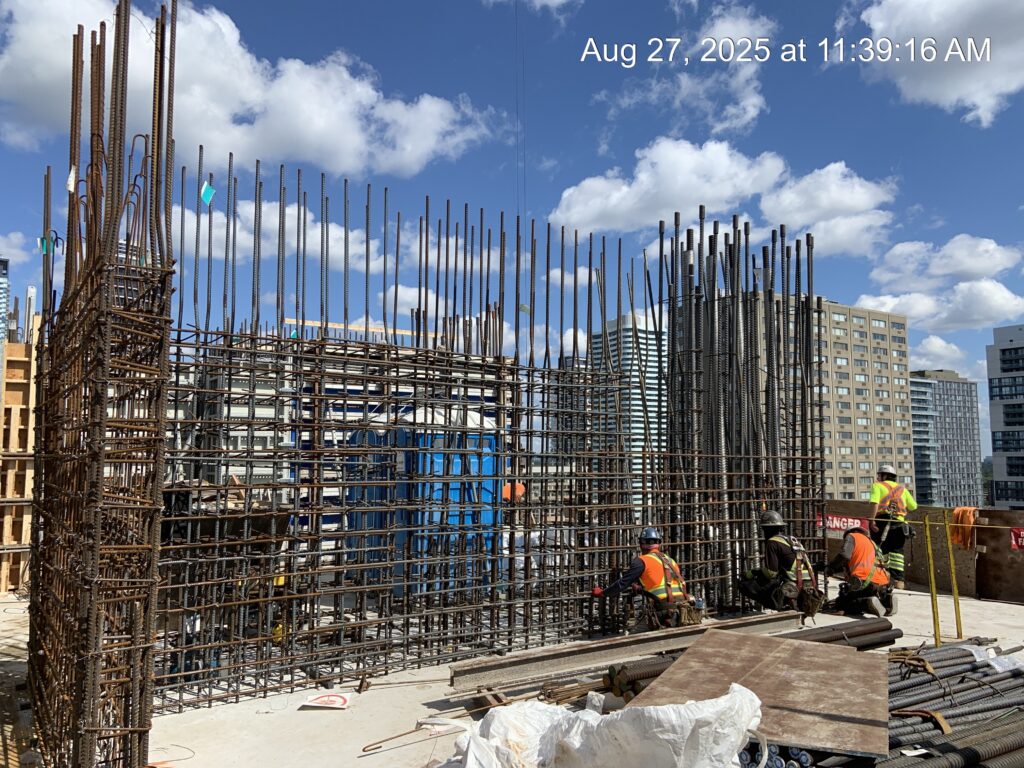

  1. Concrete pouring at Level 21 completed.
  2. Decking work ongoing at Level 22.
  3. Structural vertical elements between Levels 21–22 in progress.
  4. Mechanical and HVAC installation ongoing from Basement 1 upwards.
  5. Electrical work: wire pulling in progress at Level 19.
  6. Curtain wall installation ongoing at Level 8 and the south elevation from Level 4 to Level 9.
  7. Stair railings installation in progress from Ground Floor to Level 14.
  8. Level 10: sound insulation mats for floating floors and concrete pouring in progress
  9. Vertical firestopping at Level 4, and 5 ongoing.
  10. Horizontal fire sealant work from Level 7, 5, and 4 ongoing.

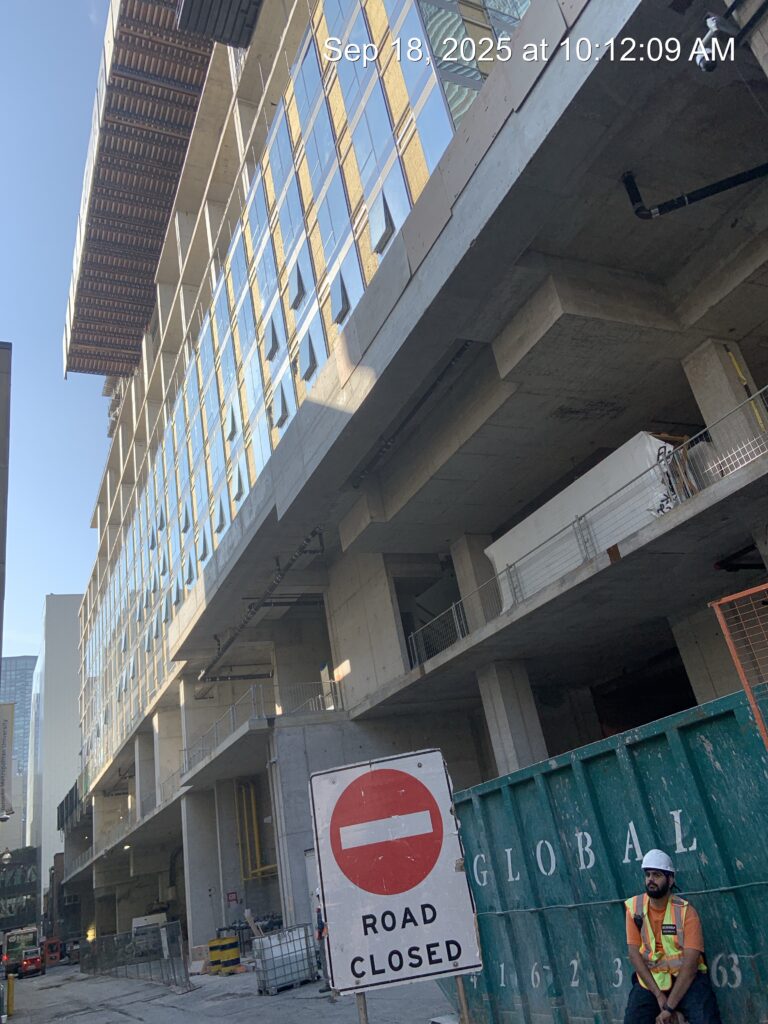

Concord SKY Project Construction Status-September 2025

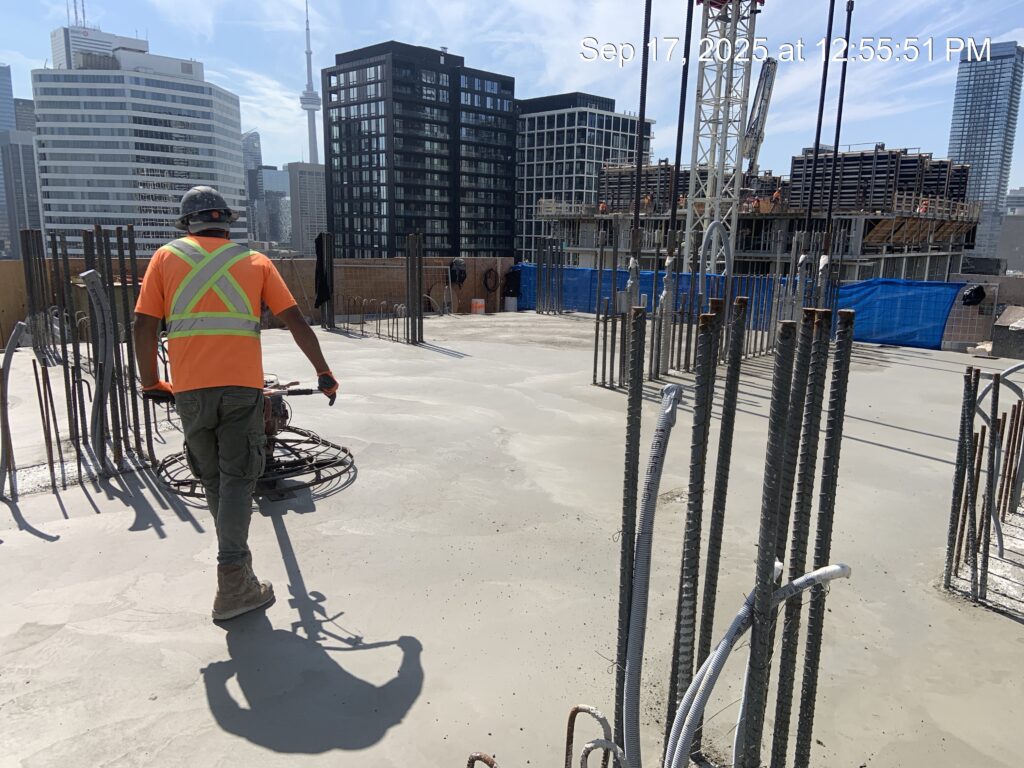

  • 19th floor concrete pouring completed.
  • 20th floor decking ongoing.
  • Structural vertical elements between L19 and L20 ongoing.
  • Mechanical and HVAC work at B01 and up ongoing.
  • Electrical pulling wires on level 17 ongoing.
  • Curtain wall installation at level 7 ongoing.
  • Stairs railing installation ongoing from ground floor up to level 14.
  • Services rooms painting below ground floor completed.

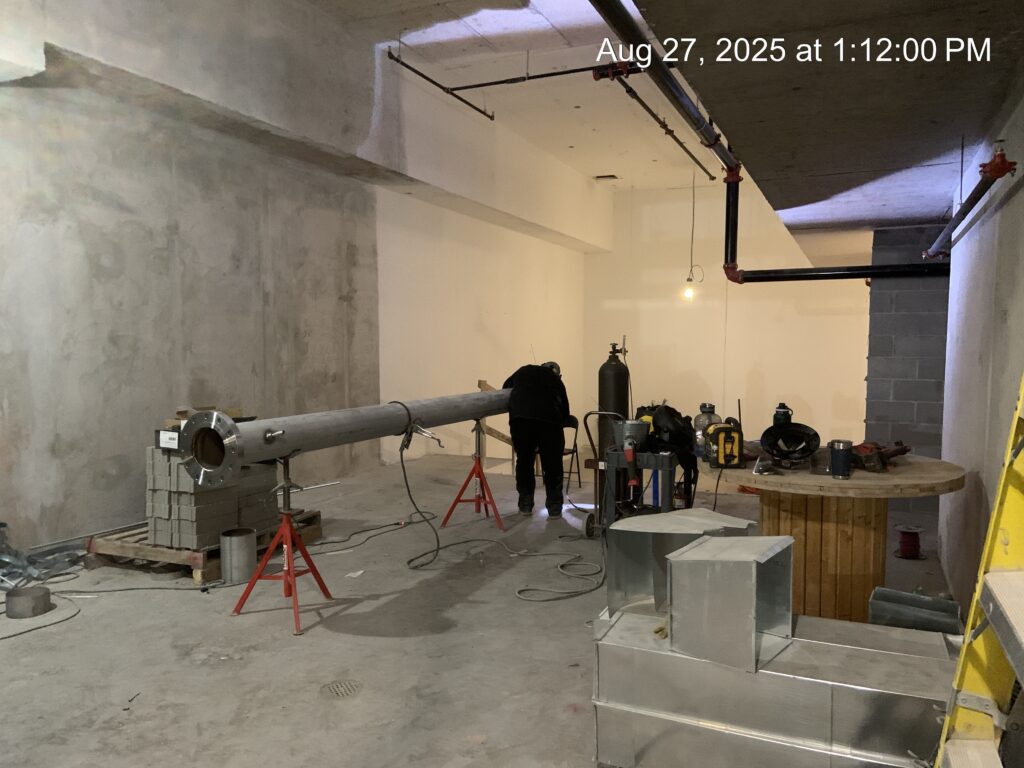

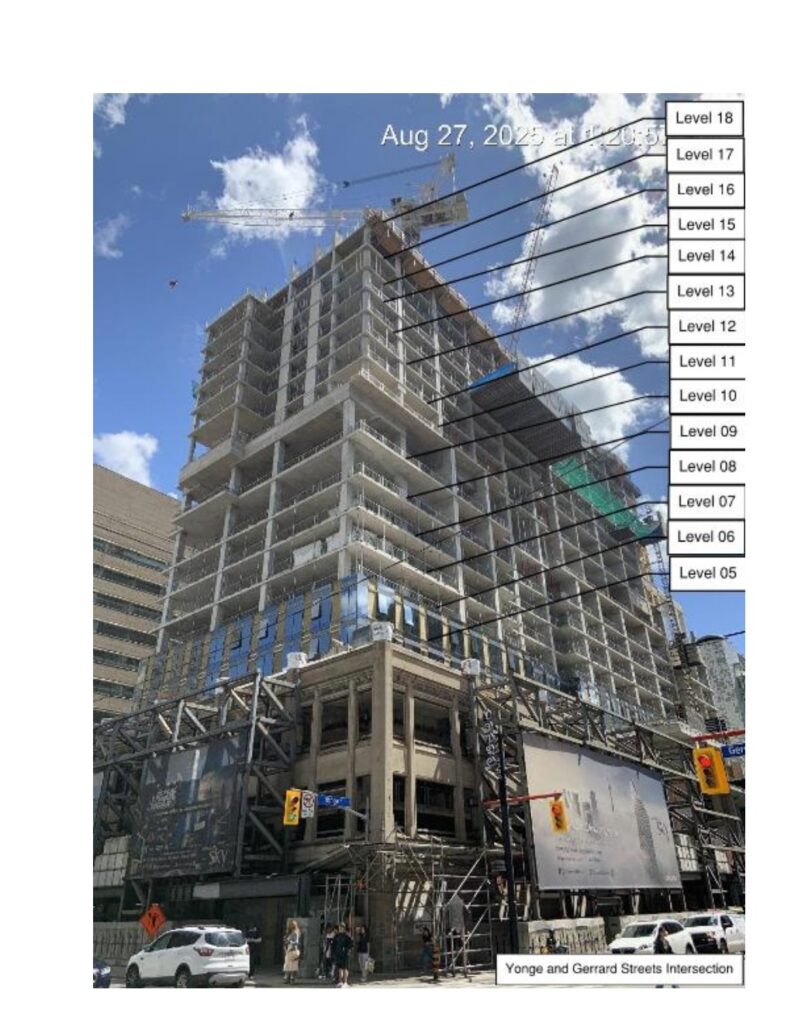

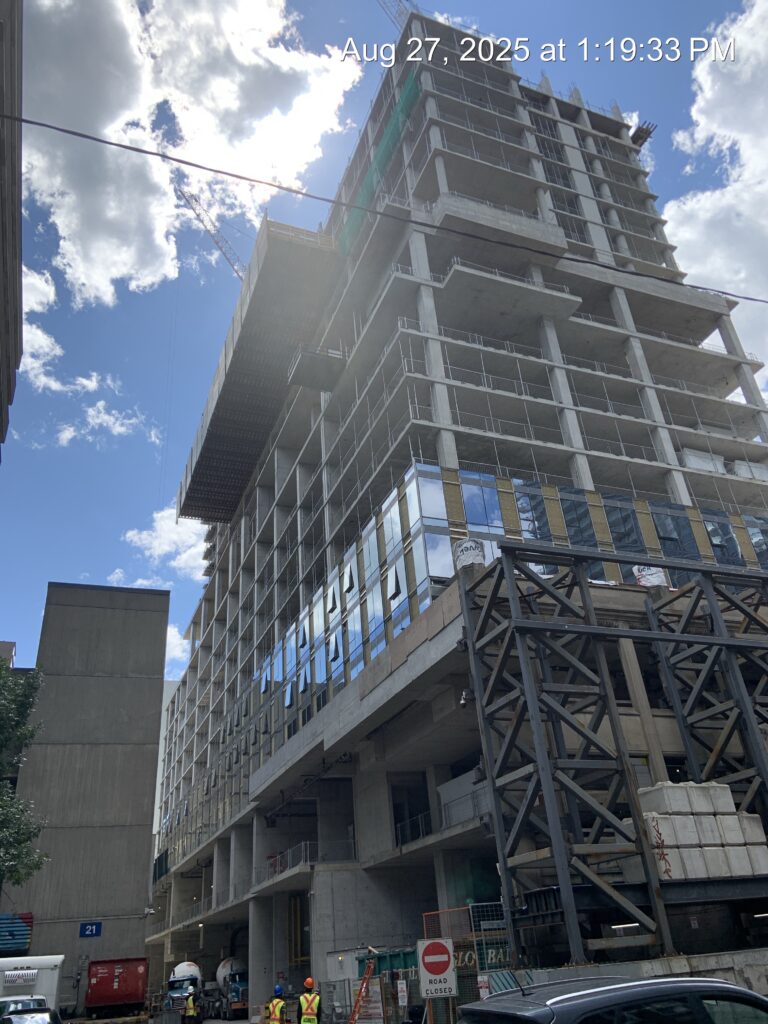

Concord SKY Project Construction Status-August 2025

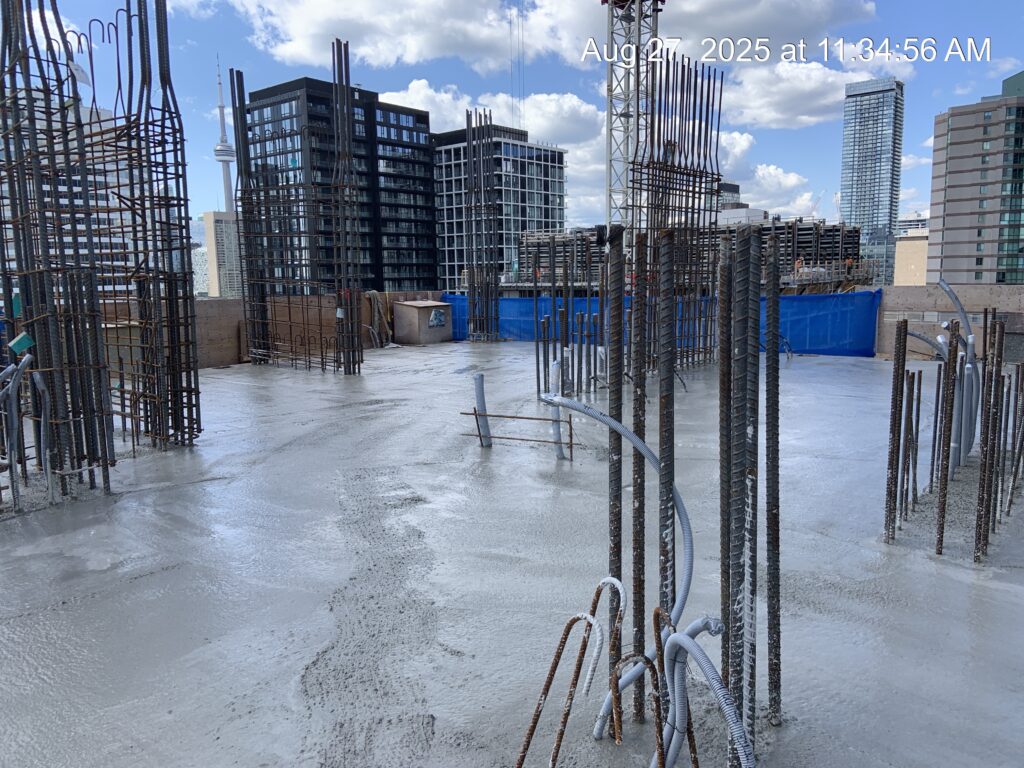

– 18th floor concrete pouring completed.
– Structural vertical elements between L18 & L19 ongoing.
– Mechanical and HVAC work B01 and up ongoing.
– Electrical pulling wires on L16 ongoing.
– Curtain wall installation on L03, L04, and L05 ongoing.
– Escalators installation completed (except the escalators railings).
– Railing installation up to L14 ongoing.

– Painting at B02, B01 and B01M services rooms completed and on B03 ongoing.

Concord SKY Project Construction Status-July 2025

  1. 16th floor concrete pouring completed.
  2. 17th floor concrete slab pouring and forming ongoing.
  3. Structural vertical elements between L17 & L18 ongoing.
  4. Mechanical and HVAC work up to L09 ongoing.
  5. Electrical pulling wires on L14 ongoing.
  6. Curtain wall installation on L03, L04, and L05 ongoing.
  7. Escalators installation ongoing.
  8. Railing installation from B05 to B01M completed and GF to L09 ongoing.

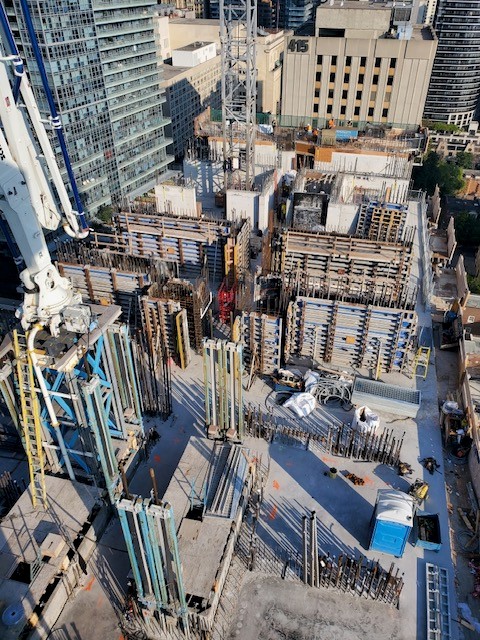

Concord SKY Project-Construction Status-May 2025

  1. 13th floor concrete slab completed.
  2. 14th floor concrete slab pouring and forming ongoing.
  3. Structural vertical elements between 13th to 14th floors and 14th to 15th floors are ongoing.
  4. MEP works up to level 9 ongoing.
  5. Stairs handrails installation completed below ground floor levels.
  6. Curtain walls delivery completed for levels 2, 4, 5, 6, 7, and 8.
  7. Garbage chute installation ongoing below ground floor levels.
